1. Introduction
Big data or data management technology has been used by many sectors to their advantage by utilizing historical data. This trend has had an impact on the construction sector [
1,
2]. To assist lessen issues with building projects, the Thai government has been at-tempting to enhance its procurement system [
3,
4,
5]. Risk avoidance, risk transfer, and risk reduction are all ways for decreasing risks in project management, but conflicts still arise [
5] and they lead to a lack of openness in how government officers do their business [
7]. A common technique that has been used in data management technology analysis is machine learning [
2,
8]. It has been used to improve the effectiveness of construction management by concentrating on analyzing historical data to generate new information or attempting to comprehend construction management behavior. [
9,
10,
11].
The Thai government has recognized the advantages and potential of implementing machine learning in the Thai construction sector [
1]. Although there may be some issues with the working process for Thai government agencies, the government will continue to look for ways to overcome them as well as ways to research [
12] the procurement system and comprehend how such a process has behaved in the past [
7]. One crucial aspect of the procurement process, in addition to streamlining the procedure, is predicting expenses before putting them up for auction [
6,
13] and establishing a standard price that adheres to the budget. That would aid in regulating the bidders' pricing [
14]. Consequently, this study intends to advance the understanding gained through the actions of procurement systems in 2019. Additionally, data was gathered from all government construction projects, including all kinds of building projects, in order to investigate and highlight the winning bidder's cost difference. to observe the behavior of the budget following the use of machine learning
Following this examination, the machine learning model was able to accurately anticipate their conduct. If they enhance their data-related goals, it may show how conventional process data collecting may help with data management.
2. Big Data in Thai Government
Nowadays, the world is driven by several forms of data [
15]. The increased usage of data has an impact on the business environment and is causing many firms to shift as competition for development intensifies. As a result, firms are enhancing their operations via the use of information technology (IT) [
16]. However, the proliferation of data within businesses has an impact on traditional analytic tools and necessitates software suppliers offering new analytical tools to manage huge volumes of data, commonly known as Big Data [
17]. Big Data (BIG DATA) refers to massive volumes of complicated data, both organized and unstructured, that typical analytical and algorithmic approaches cannot handle. The goals of BIG DATA technology are to expose hidden patterns or knowledge in vast amounts of data, which led to the creation of data-driven science [
18].
Different algorithmic strategies are used to boost productivity in different sectors [
19]. The building industry has grown alongside the revolution. The industry is faced with the acquisition of substantial volumes of data as a result of project execution [
20]. However, data from this business is difficult to use since it comes from several sources and is in varied formats. Data security has been a source of worry, and understanding is limited [
17]. However, most studies on Big Data technology only look at the benefits of employing accessible analytics data for their business rather than the readiness of technology for businesses [
16,
21]. The aim of implementing BIG DATA in businesses should be evident in that it necessitates numerous abilities such as the gathering, processing, and analysis of vast volumes of data that may arise when data from multiple sources is collected at a high velocity [
22].
Many researchers have defined that massive factors influence Big Data technology readiness. However, like any technology, these factors may differ from one organization and industry to another. [
3,
8,
9], including; Scalability, ICT infrastructure, security information, Machine learning management Support, size of organization, availability of finance, competitive pressure, organization demand, and application as well as analytic tools [
17,
23].
Big Data technology offers several options. This technology has numerous applications, such as waste minimization via design is the future of waste management research [
24] and other concepts to adopt from this technology, such as Big Data with BIM, clash detection and resolution, performance prediction, and so on [
25]. The building sector has been enabling a digital revolution to take place. They are implementing Big Data technology in Building Information Modelling (BIM) by handling building project data. BIM data is often 3D geometrically encoded, computationally intensively compressed, in a variety of proprietary formats, and interconnected. Accordingly, the data are enriched gradually and persisted, although project life cycle that make BIM files can quickly get voluminous, with the building model easily achieving fifty gigabytes in size [
26,
27].
3. Big data in Thai government
Government procurement is crucial to a country's growth since it requires the government to spend budget funds on supplies for public services such as education, safety, security, and facilities, among other things. Government procurement is said to be the primary source of funding for public services and government entities [
28]. As a result, the sole factor restricting government spending is the quality of the procurement analysis. However, effective procurement does not always imply paying the lowest price. Instead, the acquisition is motivated mostly by the desire to advance the nation's technology and industry. [
29]. Procurement has expanded rapidly in many countries to support the rise of national and international economies. Procurement is important because it assists the essential and enabling parts of the public and commercial sectors. As a result, in order to become more flexible, the public procurement system must rapidly develop and adapt. The evolving missions of the public, corporate, and civil society sectors have resulted in more efficient, transparent, and effective public and private procedures. The administrative system is shrinking, but it is also becoming more adaptive and efficient [
30]. The government may provide assistance to the private sector so that both sectors can benefit the country and progress indefinitely. As a result, in this day and age, information technology is essential in both the public and private sectors, and it is critical to every organization. This is because having rapid access to a large amount of current information makes work more efficient [
31]. Government expenditure accounts for 10% to 15% of each country's gross domestic product (GDP). Furthermore, it is estimated that the annual building expenditure is approximately
$2 billion [
32]. However, present government procurement methods fall well short of adequately meeting the demands of stakeholders. According to research and the media, it is the result of a variety of procurement issues, including corruption in government construction procurement projects, procurement costs that are higher than actual costs, cronyism that results in subpar work, additional costs or budget losses, and/or subpar, overpriced materials [
33].
The project owner or person in control makes the decision to start a construction project. The project owner must outline a detailed scope of work in every area [
28,
34], and the project can also be handled by hiring contractors for each component of the task [
6]. When selecting a contractor, the typical cost of the project is also an important factor to consider [
13] [
14]. The Thai government is in charge of developing standard pricing for all government construction projects in order to enter the data into the electronic government procurement (e-GP) system [
14]. The government would handle the procurement process for each project as the project owner after setting the budget based on the proposal presentation [
14]. The incorrect project cost is also such an important piece of information that it enhances the risk of a disagreement [
5,
13,
35]. As a result, cost estimate is critical for government personnel who are involved in operations [
6]. According to government data, it is still impossible to achieve a price that is greater than the project budget. Furthermore, the project's usual cost surpasses the project budget, affecting how government funds are administered. It is the cause of the excess and lost value gaps [
1,
7]. As a result, machine learning classification approaches may be utilized to create solutions to understand the behavior and investigate the influence of disagreement in standard pricing estimates [
2,
36].
4. Algorithm of machine leaning in this research.
The purpose of machine learning (ML), a branch of artificial intelligence (AI), is to enable computer systems to learn about a certain job automatically from data. A number of methodologies are used to model judicial reasoning and forecast litigation outcomes, including rule-based learning strategies [
37], artificial neural network techniques [
38], case-based reasoning tactics, and hybrid methodology [
39].
4.1 Artificial neural network algorithm (ANN)
There are various types of artificial neural networks (ANNs). Classification and function estimation are ideal applications for Artificial Neural Networks (ANNs). These algorithms have been widely employed to solve difficult industrial issues since their inception. The most common type of ANN is the multi-layer perceptron (MLP). An ANN is made up of three layers: the input layer, the hidden (intermediate) layer, and the output layer. Through deep learning, ANN algorithms have recently changed machine learning. All the ANN applications used in the construction sector demand special attention, and new ANN algorithms are being developed to learn from data with a huge dimensionality (i.e., Big Data) [
40]. Equation 1-2 should be used to refer to the hidden units in the neural network model that are shown in

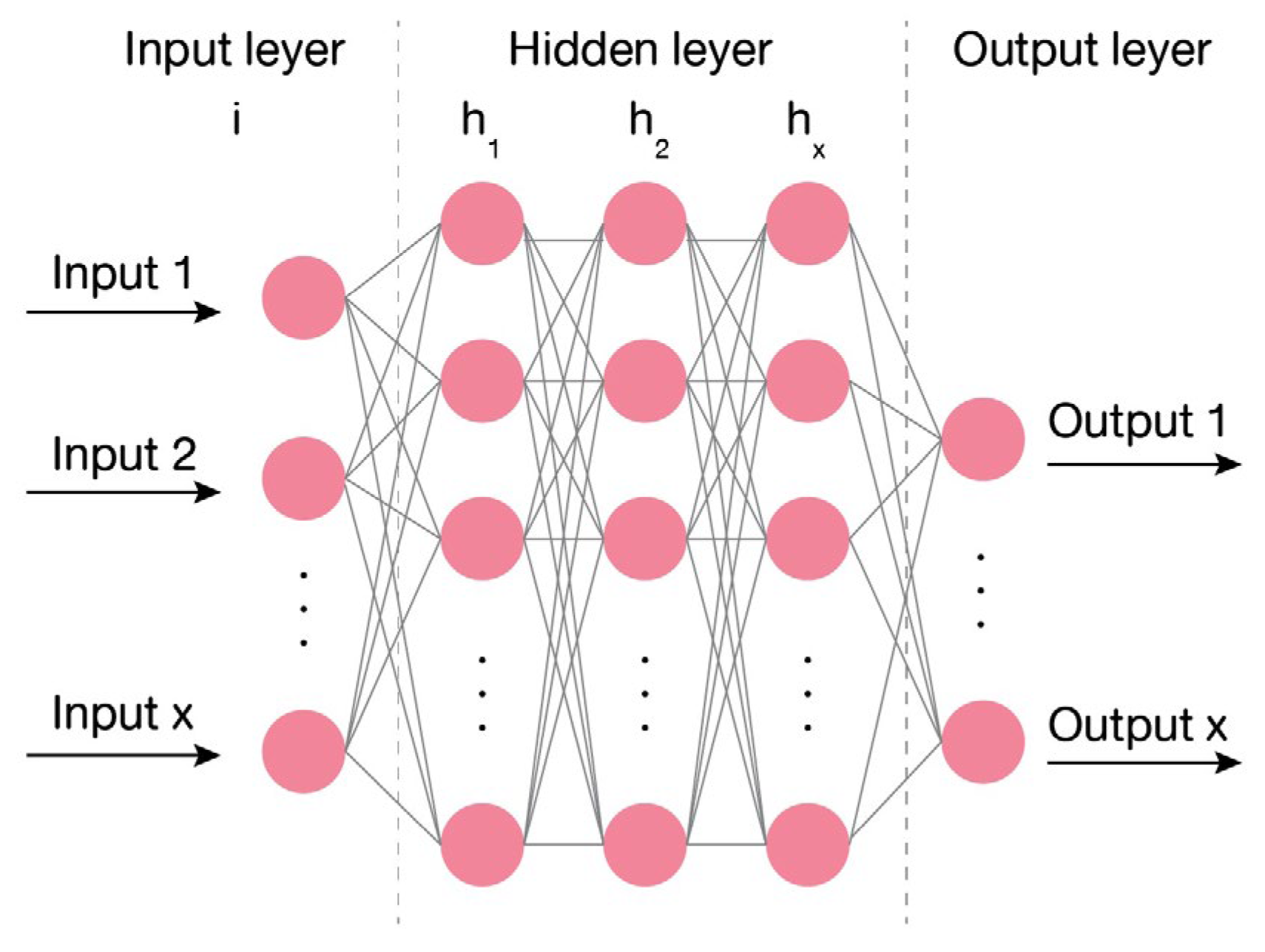

Figure 1 [
41].
It is built up here in two steps. First the K activations Ak, k = 1, . . ., K, in the hidden layer are computed as functions of the input features X1, . . ., Xp,
4.2. Decision tree algorithm
Frameworks for making decisions. The latest machine learning approach for predicting qualitative and quantitative goal variables is decision trees (DTs). The creation of DT begins with the discovery of the decision node. The nodes are then separated recursively until no further divisions are feasible. Two metrics used to test the robustness of DT, which is dependent on the logic used to split nodes, are information gain (IG) and entropy reduction [
40]. exemplifies a simple decision tree model with a single binary goal variable Y (0 or 1) and two continuous variables x1 and x2, all of which span from 0 to 1.

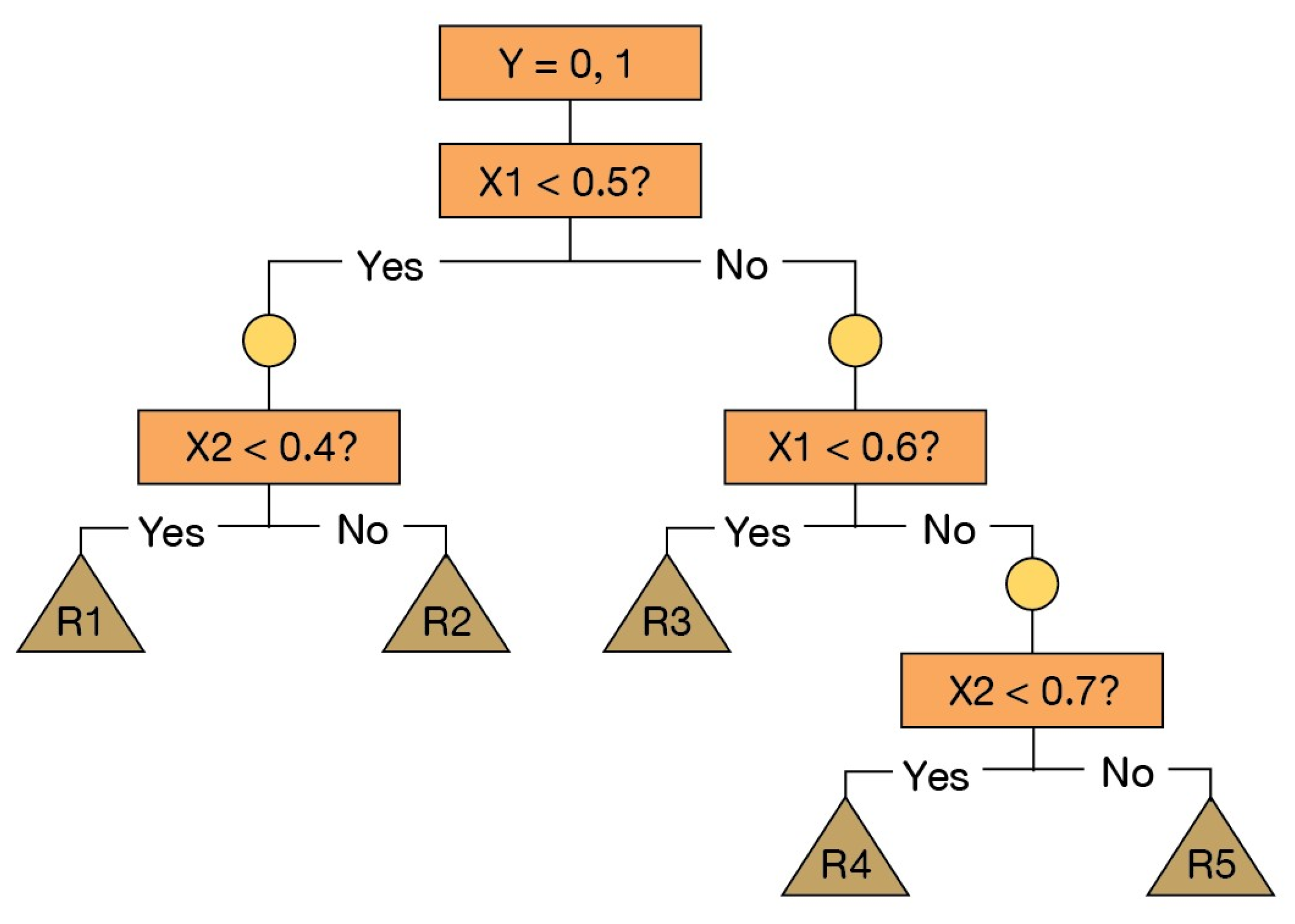

Figure 2 depicts the basic components of a decision tree model: nodes and branches. [
41], and splitting, pausing, and pruning are the key modeling procedures.
4.3. K-Nearest Neighbors
KNN is a non-parametric approach used in regression and classification. KNN has been used successfully for classification in a variety of applications. The separation between each item in a training set and each item in a test set is calculated using this approach; keep in mind that the K items in the training set are the KNN. The test set items are then classified based on the most frequent class in the KNN, with each neighbor having the opportunity to vote. (If there is a tie, the voting procedure includes any training set items that are not further distant than the Kth nearest neighbors, resulting in a vote total larger than K.) A few scientists have considered the most precise way of measurement. They have employed global and local measurements in their initiatives, although these indicators are problem specific. Until now, the most widely used metric has been Euclidean distance, which calculates distances between two points by calculating the square root of the sum of the squared distances across each coordinate (possibly weighted) between [
42] and [
43].
5. Algorithm of machine leaning in this research.
Artificial intelligence (AI) is one of the major technologies driving Industrial Revolution 4.0. It is a type of artificial intelligence that has been programmed into computers to assist in the automatic replication of intelligent actions comparable to those of humans. In other words, AI uses machines, namely computer systems, to imitate human reasoning and learning processes. This method includes comprehension (the accumulation of knowledge and the rules that govern its application), reasoning (the application of rules to arrive at approximations), decision-making, and self-correction. "Machine learning" is a subfield of artificial intelligence (AI) technology. [
44]. Classification, grouping, and regression problems are tackled in this multidisciplinary area by integrating statistics, computer science, and optimization skills. Machine learning, then, is a system's capacity to learn from data. It can make judgments based on previous experience in comparable situations, deal with ambiguity and limited data, and more [
45]. A number of research on the application of machine learning in construction and project management have been conducted in recent years, although they are still quite restricted. They employed machine learning to classify construction papers based on project components.
The KNN classification algorithm was used to establish a model of awareness and information sharing, as well as to improve the present construction information management system's quality. The proposed technique may be used in projects to assist diverse stakeholders in identifying and mitigating the risk of legal change conflicts [
46,
47]. The cost and timeline of building projects may be calculated using an artificial neural network (ANN) and other models [
48]. According to the findings, early planning is critical to the success of a project. They created a text classification approach based on machine learning to classify contract general conditions provisions. This method makes it easier to assess the automatic compliance of text-based construction contracts [
49]. Using neural networks and linear regression, a construction cost index for concrete structures was created based on historical records of main construction costs. Their key contribution was to provide stakeholders with a credible method of forecasting pricing for prospective project developments [
50].
The Thai government's procurement process has been particularly effective in obtaining and storing data in an electronic system [
31], and it also has a procurement process management philosophy for building projects [
51]. Furthermore, the system may enable developing technologies, which have a proclivity to learn from past events in order to address current challenges and improve enterprises [
52]. Data collecting from government research efforts has also yielded some unusual findings. To verify whether the data obtained is acceptable for ML, the Thai government agency in charge of procurement must produce and discover data anomalies [
53].
The previous research acquired data from Thailand's conventional government system. The four data characteristics are department name, site location, procurement method, and project type. The authors developed an ML-based model for anticipating over-budget projects. The produced model, which had an accuracy of 0.86, was built using the KNN approach. This study demonstrated that some of the Thai government's obsolete data may be used to develop cutting-edge technologies such as machine learning. ML has a progress goal, even if it is a component of big data for processing massive amounts of data. Finally, the study could show that big data and machine learning methodologies can successfully use even a little quantity of data from the Thai government [
54], and this study used a large amount of data from the e-GP system. The information was gleaned from more than 200,000 construction projects in Thailand. Hyperparameter.
The optimization of hyperparameters can be simplified by determining how many function evaluations will be performed on each optimization in order to identify the optimal hyperparameter in that model. Furthermore, optimization may be defined as "given a function that accepts inputs and returns a numerical output, how can it efficiently find the inputs, or parameters, that maximize the function's output?" [
55]. As a result, while tuning or optimizing the hyperparameter, the author will accept input as a function to the hyperparameter model and output as a measurement of model performance [
56]. This is the rate of miscalculation or mistake. The hyperparameter space contains all of the potential values that are often established as acceptable boundaries for each hyperparameter, and the number of hyperparameters equals the function's dimension [
58].
According to prior research, adjusting the hyperparameter necessitates understanding of the link between the settings and model performance. It will first conduct a trial to collect performance data on several settings, and then make an inference to choose which configuration will be used next. The goal of optimizing is to reduce the number of trials on hyperparameters while identifying the best model [
59]. As a result, the author might regard the process as sequential rather than parallel.
6. Conceptual framework
The conceptual underpinning of this study is the procurement practices of the Thai government in a government building project. The research will enter conventional data for analysis using a machine learning technique to predict the winning price and compare it to the project budget. based on
Figure 3. While W meaning winning price and B meaning project budget.
7. Research methodology
The computerized government procurement system was used to collect the data for this investigation (e-GP). The data may be accessed with authorization from the comptroller general's office so that it could be gathered. The required data includes all 2019 government construction projects, with a total of about 283,000 projects, including the three scenarios that were the subject of this study: standard price over project budget, winning price over standard price, and winning price over project budget. Da-ta was separated into two categories based on how it was collected: 20% of the data was used for model validation, and 80% of the data was utilized for model training. Additionally, an Artificial Neural Network (ANN) was used to assess the training da-ta, and the results were validated using a confusion matrix [
2,
59]
7.1. Application of machine learning
The collected data had to be structured in a CSV file to ensure there were no blank values or categories with unknown contents. ANN also requires the use of computer software. The buried layer of the ANN is 100 [
60] in size. Anaconda software was used to run the Python-based computer application.
7.2. Verifying the Model
Building a confusion matrix and using the following equations (3-5) allowed the ANN model's accuracy, precision, and recall to be checked [
61]. where TP, TN, FP, and FN represent the true, false, and positive states, respectively.
The proportion of total accurate classifications to total predicted classifications is used to measure a model's accuracy. Another definition of precision is the ability to obtain consistent results from a variety of measurements. In information retrieval, random error is a sort of observational error that results in differences between precise values. [
59].
7.3. Hyperparameter optimization with random search
Machine learning models contain hyperparameters that must be set in order for the model to be customized to your dataset. The general effects of hyperparameters on a model are frequently understood, but determining how to optimally set a hyperparameter and combinations of interacting hyperparameters for a given dataset can be difficult. For configuring hyperparameters, there are frequently broad heuristics or rules of thumb. A better technique would be to objectively search different values for model hyperparameters and select a subset that results in a model that performs best on a particular dataset. This is known as hyperparameter optimization or hyperparameter tuning, and it is supported by the scikit-learn Python machine learning toolkit. The result of a hyperparameter optimization is a single set of well-performing hyperparameters that you can use to configure your model [
56].
Hyperparameters are points of choice or configuration that allow a machine learning model to be tailored to a given job or dataset. Model configuration argument given by the developer to guide the learning process for a specific dataset. Machine learning models also have parameters, which are the internal coefficients determined by training or tuning the model using a training dataset. Parameters differ from hyperparameters. Parameters are learned automatically; hyperparameters are set manually to aid in the learning process. In general, a hyperparameter has a known effect on a model, but it is unclear how to optimally configure a hyperparameter for a given dataset. Furthermore, many machine learning models feature a variety of hyperparameters that might interact nonlinearly. As a result, it is frequently necessary to look for a set of hyperparameters that result in the greatest performance of a model on a dataset. This is known as hyperparameter optimization, tweaking, or hyperparameter search [
58].
A search space is defined as part of an optimization technique. This can be visualized as an n-dimensional volume, with each hyperparameter representing a separate dimension and the scale of the dimension being the values that the hyperparameter can take on, such as real-valued, integer-valued, or categorical. The Random Search defines a search space as a bounded domain of hyperparameter values that is randomly sampled [
56].
7.4. Data Collection
Seven characteristics of the input data gathered from the conventional Thai government system are displayed in
Table 1 below. According to its definition, each parameter has a unique factor and the first parameter is the groups of department name attribute, which includes 13 groups of departments in Thailand including University School Hospital Irrigation Public works and town and country planning Highway Rural road Finance Local of administration Justice Police Soldier and other.
Furthermore, the project owner is one of the parties involved in building project conflicts [
13,
15]. Furthermore, these are the key aspects that influence cost estimation. The project type characteristic is made up of three components, including attempts to develop roads and install irrigation systems [
14]. This trait has a considerable influence on project cost estimation, budgeting, and procurement [
21]. The Thai procurement method characteristic, as shown in
Table 3, consists of three components, including the chosen bidding method and the specific methodology. Furthermore, each country has its own procurement system, but the final aim is the same: the abolition of corruption [
18].
It has a considerable impact on a contractor's cost when using the procurement technique [
14,
18]. Project levels also come in five levels. According to the price ranges, the levels are divided as illustrated in
Table 4 [
3,
62]. The length of a construction project as specified by the contract is referred to as "duration." In the case of project qualities, the question of whether a project is under or over budget considering Thai government policy is considered. It is made up of two components.
8. Result
Three components make up the study's findings: general information, a machine learning model, and a model that has been verified.
8.1. General Information.
The specific approach, which accounts for 77.8% of all procurement methods, is the one that the Thai government prefers the most. The largest group of departments is classified as "Other," which accounts for 67.5 percent of Thai government data in 2019. The departments with the highest budgets, however, are local government and highways, as seen in

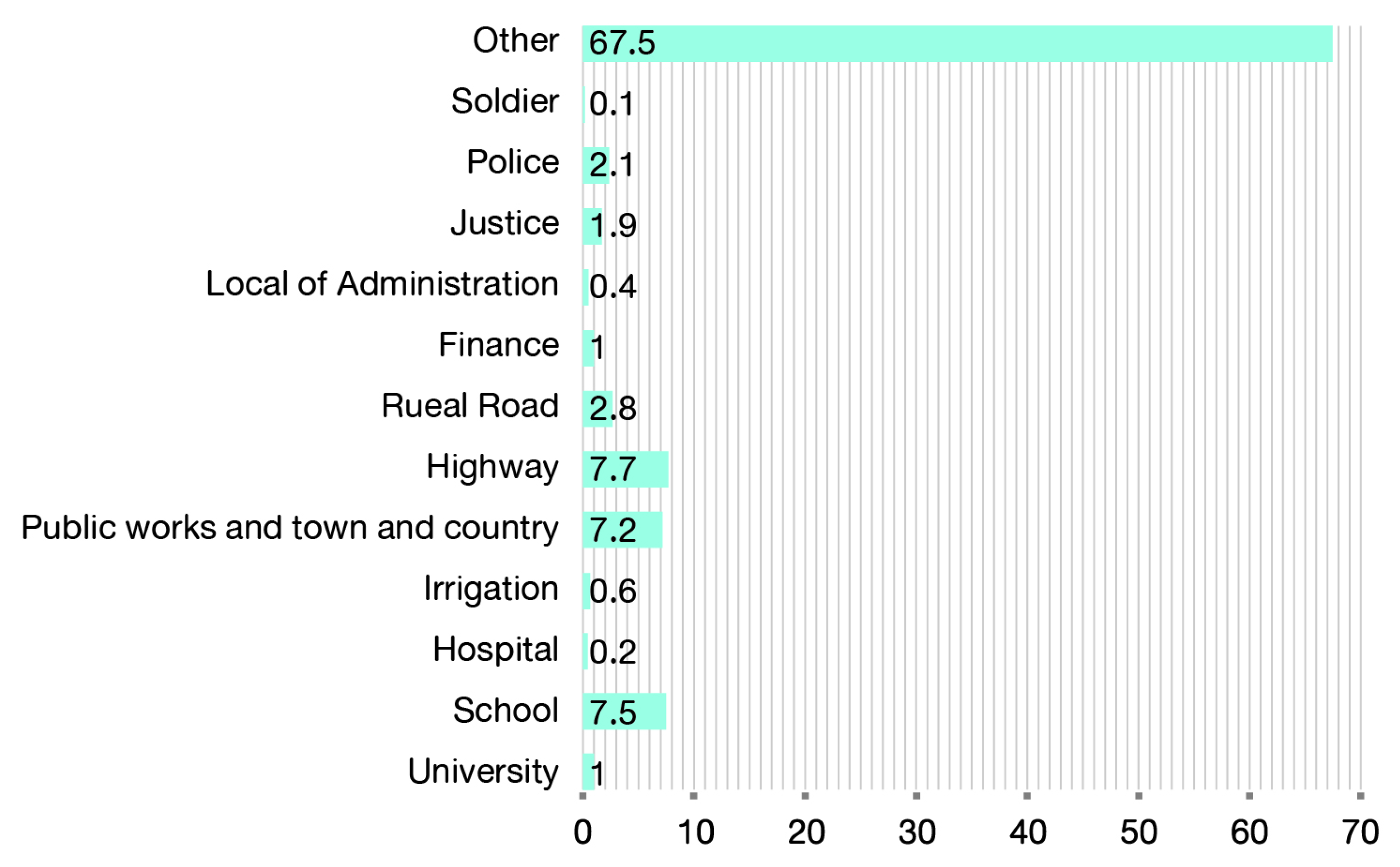

Figure 4. Roads and buildings are the main construction projects undertaken by the Thai government. As seen in
Figure 5, one of the numerous concerns that the Thai government is most worried about for the Thai people is infrastructure [
7,
14]. This study classified the budget situation into two categories, standard price over budget and winning price over budget, as shown in
Figure 6 and

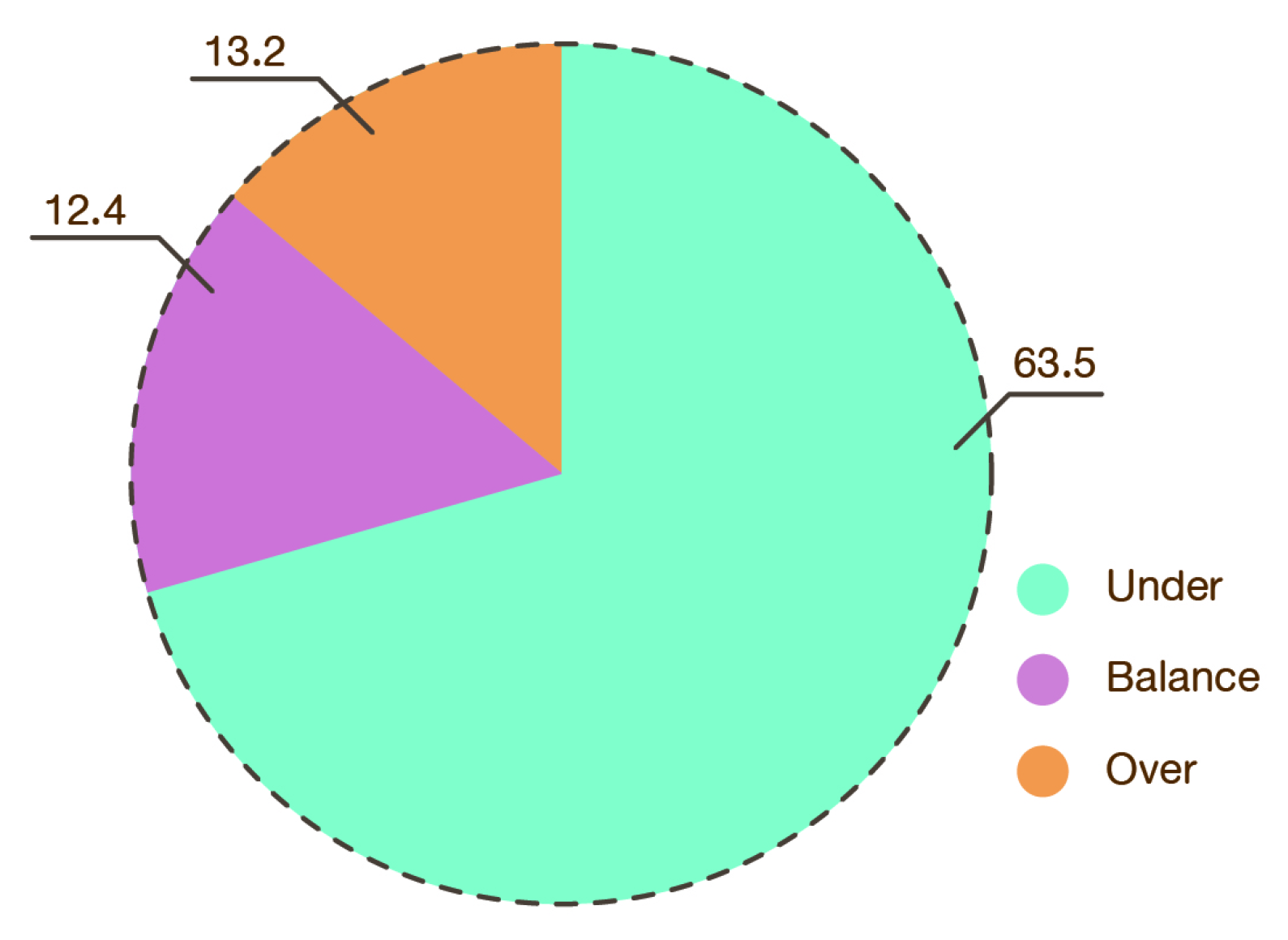

Figure 7. This study aims to predict the winning price in a budgetary circumstance. A few successful projects have prices that are greater than anticipated due to the overall formation. This is an important aspect of the study, though, as police are prone to corruption [
7]. The government's cost evaluation process is defective since there are 700 projects where the winning price is higher than the standard price [
5,
6]
8.2. Machine learning model
There are three algorithms used to generate the model for categorizing the behavior of Thai government construction project bidders: ANN, Decision tree, and KNN.
Table 5 shows that the accuracy of the algorithms is approximately, while the ANN algorithm has the greatest percentage at 77.60. According to accuracy for beneficial, it must be greater than 75% [
63].
8.3. Validating data with confusion matrix
The confusion matrix [
64] is used to calculate the classification accuracy of the model. The ANN model matrix revealed that the model properly predicted 44,028 out of 56,705 instances. As a result, as shown in
Figure 8, the grey box is misclassified and the white box is correctly classified, and the number zero in the confusion matrix table indicates that the model did not make a mistake in forecasting for each scenario. Similarly, the accuracy of the ANN model may be determined using the confusion matrix. As indicated in
Table 6, accuracy may be split into three categories of bidding behavior (under, balance, and above). For the first case, under cluster, the model achieved a precision of 83%. Balance cluster, the model achieved a precision of 77%. Over cluster, the model did not achieve a precision score. as shown in
Table 6.

The matrix of decision tree model showed that the model correctly predicted for 44,050 from 56,705 cases. Therefore, the grey box is misclassified and the white box is correctly classified as show that in

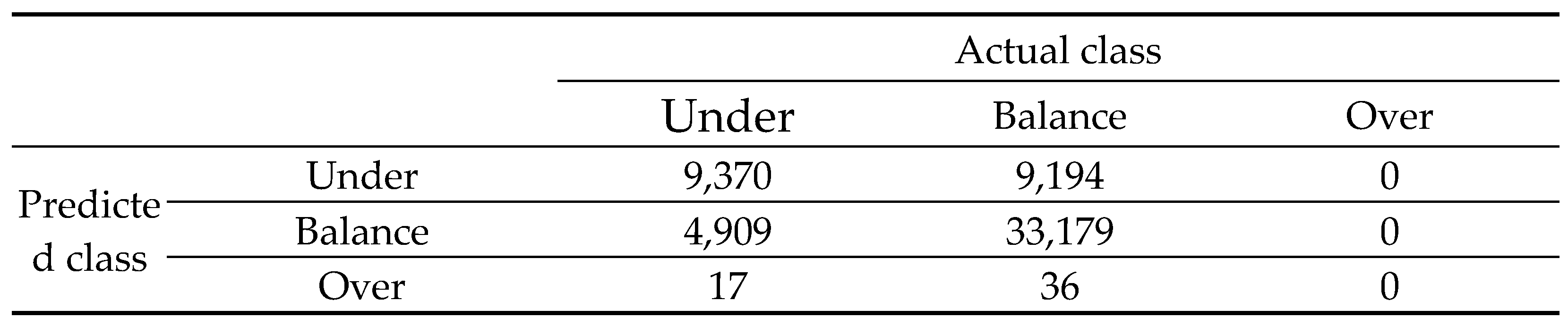

Figure 9 and the number zero in confusion matrix table means that the model didn’t make a mistake in predicting for each case. Similarly, the decision tree model’s precision can also be calculated by using the confusion matrix. The precision can be divided into three cases of bidding’s behaviours (i.e., Under, Balance, and Over. For the first case, Under cluster, the model achieved a precision of 81%. Balance cluster, the model achieved a precision of 77%. Over cluster, the model did not achieve a precision score. as shown in the
Table 7.
The matrix of KNN model showed that the model correctly predicted for 42,549 from 56,705 cases. Therefore, the grey box is misclassified and the white box is correctly classified as show that in
Figure 10 and the number zero in confusion matrix table means that the model didn’t make a mistake in predicting for each case. Similarly, the KNN model’s precision can also be calculated by using the confusion matrix. The precision can be divided into three cases of bidding’s behaviours (i.e., Under, Balance, and Over). For the first case, Under cluster, the model achieved a precision of 66%. Balance cluster, the model achieved a precision of 78%. Over cluster, the model did not achieve a precision score. as shown in the
Table 8.
The precision of confusion matrix has shown that the ANN algorithm could show the highest accuracy in all the case however KNN could perform high efficiency with ANN for Balance case. this point could prove that the traditional data have a relation for application data technology [
2]. The performance of classification algorithms is typically assessed by evaluating the accuracy of the classification artificial neural networks may be utilized and good results can be achieved from classification algorithms [
65]. as shown in
Table 9. However, the over case cannot be processes because of the data that have a little and this case can happen in a few times. According to this, the procurement in Thailand is efficiency process.
8.4. After hhyperparameters tuning.
In the final experiments, underperforming hyperparameters were removed. The Random search technique randomly samples the hyperparameter space. According to [
66], random search has more advantages than grid search in terms of application that can be used even if the computer cluster fails. It enables practitioners to adjust the "resolution" on the fly, as well as add additional trials to the set or even disregard the fail test. At the same time, the random search procedure may be stopped at any time, forming a full experiment that can be carried out concurrently [
67]. Furthermore, if more computers become available, a new trial may be added to the experiment without compromising it [
68]. The following are the primary parameters for each model. The main parameters for each model are as follows. ANN model : random_state = 42, hinden layer sizes = 20, alpha = 0.001 and activation = tanh, Decision tree model: random_state = 42, min_samples_leaf = 4, max_depth = 10 and n_iter = 10. KNN model: 'kneighborsclassifier__weights': 'distance', random_state = 42, min_samples_leaf = 10, n_neighbors = 7, n_iter = 10 and algorithm = kd_tree as show that in the the 11.
5. Discussion
The method of procurement attribute in the input data is crucial for increasing the model's predictive performance [
14]. One of the three methods of procurement used by the Thai government was created specifically for small-scale projects like the reinforcing of concrete roadways and tiny buildings. The special technique was created by the government for preferred contractors, whose ability to finish projects quickly could be guaranteed by the government. This approach has the advantage of delivering built amenities to people more quickly than the bidding technique. Government officials can therefore participate in a variety of activities during a particular method as one of the elements influencing the procurement process, provided that their actions are not monitored and recorded [
69]. The procurement regulation does, however, include a shortcoming that hurts the government's reputation. This procurement approach has a fault in that it is only appropriate for modest projects. Furthermore, only government agencies have the authority to choose contractors in a direct, straightforward manner. Project auditing is a department that exists, although it cannot audit every single project. Another study indicates that a key contributing factor to corruption is a government agency [
3].
The application's goal, such as storage to support data technology to collect data, depends on the data technology infrastructure [
12]. This study makes sure that the Thai government's data collection procedures are effective and of high quality. The building industry, however, might gain greatly from the adoption of data technology and Big Data technologies, and this would be a developed nation [
2]. They should, however, design their digital data collection in such a way that it supports the Big data concept and is a developed country with current technology.
9. Conclusions
This study demonstrates that the ANN's accuracy rate was 78.9 percent. In the current analysis, data from Thailand's conventional government system were employed. Group of Departments, Project Type, Procurement Method, Duration, Standard Price Over Budget, Winning Price Over Standard Price, Standard Price Over Budget, and Winning Price Over Standard Price are among the eight characteristics. The effectiveness of four algorithms showed that the data may be utilized to accurately forecast behaviour.
The budgeting process is one of important for government construction project management that need to be finish before auction process. The auction in procurement management in government define project budget early and a budget for a construction project is crucial since it may assist to save time and money over the course of the project. You will be able to take the necessary actions to guarantee that the building project stays within the budget after you have properly planned for it.
Finally, this study can demonstrate that the Thai conventional data gathering technique can be used with machine learning from Big data. According to this, the data used to create machine learning models is raw data obtained from the procurement system. However, even though we did not change or tweak the settings, the outcome was still better. If they enforce their policy to enhance data gathering techniques, the data will be more efficient and productive.
Author Contributions
Conceptualization, W.K. and K.S.; methodology, W.K. and K.S.; software, W.K.; validation, W.K.; formal analysis, W.K.; investigation, W.K.; resources, K.S.; data curation, K.S.; writing original draft preparation, W.K. and K.S..; writing review and editing, T.C; visualization.; supervision, K.S.; project administration, K.S. and T.C. All authors have read and agreed to the published version of the manuscript.
Funding
This research received no external funding.
Data Availability Statement
The data used to support the findings of this study are available from the corresponding author upon request.
Acknowledgments
We would like to sincerely thank the faculty of engineering, Khon Kaen University for their funding support. In addition, we would like to thank the comptroller general's department for allowing their data to be used in this study. Without any of them, our research would not be accomplished.
Conflicts of Interest
The authors declare no conflict of interest.
References
- Srinavin, K.; Kusonkhum, W.; Chonpitakwong, B.; Chaitongrat, T.; Leungbootnak, N.; Charnwasununth, P. Readiness of Applying Big Data Technology for Construction Management in Thai Public Sector. J. Adv. Inf. Technol. 2021, 12, 1–5. [Google Scholar] [CrossRef]
- Bilal, M.; Oyedele, L.O.; Qadir, J.; Munir, K.; Ajayi, S.O.; Akinade, O.O.; Alaka, H.; Pasha, M. Big Data in the Construction Industry: A Review of Present Status, Opportunities, and Future Trends. Adv. Eng. Inform. 2016, 30, 500–521. [Google Scholar] [CrossRef]
- Chaitongrat, T.; Leungbootnak, N.; Kusonkhum, W.; Deewong, W.; Liwthaisong, S.; Srinavin, K. Measurement Model of Good Governance in Government Procurement. IOP Conf. Series: Mater. Sci. Eng. 2019, 639, 012024. [Google Scholar] [CrossRef]
- Soni, S.; Pandey, M.K.; Agrawal, S. Conflicts and Disputes in Construction Projects: An Overview. Int. J. Eng. Res. Appl. 2017, 7, 40–42. [Google Scholar] [CrossRef]
- Jaffar, N.; Tharim, A.H.A.; Shuib, M.N. Factors of Conflict in Construction Industry: A Literature Review. Procedia Eng. 2011, 20, 193–202. [Google Scholar] [CrossRef]
- Rose, K. A Guide to the Project Management Body of Knowledge (PMBOK® Guide)-Fifth Edition. Proj. Manag. J. 2013, 44, e1. [Google Scholar] [CrossRef]
- Chaitongrat, T. Causal relationship model of problems in public sector procurement. Int. J. GEOMATE : Geotech. Constr. Mater. Environ. 2021, 20. [Google Scholar] [CrossRef]
- Hurwitz, J.; and Kirsch, D.; Machine Learning for Dummies, IBM Limited Edition. 2018. p. 75.
- Bai, S.; Li, H.; Kong, R.; Han, S.; Li, H.; Qin, L. Data Mining Approach to Construction Productivity Prediction for Cutter Suction Dredgers. Autom. Constr. 2019, 105, 102833. [Google Scholar] [CrossRef]
- Naganathan, H.; Chong, W.C.; Chen, X.-W. Building Energy Modeling (BEM) Using Clustering Algorithms and Semi-Supervised Machine Learning Approaches. Autom. Constr. 2016, 72, 187–194. [Google Scholar] [CrossRef]
- Poh, C.Q.X.; Ubeynarayana, C.U.; Goh, Y.M. Safety Leading Indicators for Construction Sites: A Machine Learning Approach. Autom. Constr. 2018, 93, 375–386. [Google Scholar] [CrossRef]
- Chonpitakwong, B.; Kusonkhum, W.; Chaitongrat, T.; Srinavin, K.; Charnwasununth, P. Hindrance of Applying Big Data Technology for Construction Management in Thai Government. J. Adv. Inf. Technol. 2021. [Google Scholar] [CrossRef]
- Jervis, B.M.; Levin, P.T. Construction Law, Principles and Practice; 1988.
- The Comptroller General’s Department. The Government Procurement and Supplies Management Act B.E. 2560. The Comptroller General’s Department. 2017.
- Deal, J.L. Information ShiftBig Data: A Revolution That Will Transform How We Live, Work, And Think By Mayer-Schonberger Viktor Cukier Kenneth New York (NY) : Houghton Mifflin Harcourt, 2013, 242 Pp., $27.00. Health Aff. 2014, 33, 1300. [Google Scholar] [CrossRef]
- Michael, K.; Miller, K. Big Data: New Opportunities and New Challenges [Guest Editors’ Introduction]. IEEE Comput. 2013, 46, 22–24. [Google Scholar] [CrossRef]
- Big Data Analytics; Springer Science+Business Media, 2018.
- Creely, E.; Henriksen, D.; Henderson, M. Artificial intelligence, creativity, and education: Critical questions for researchers and educators. In Proceedings of the Society for Information Technology & Teacher Education International Conference, 2023; pp. 1309-1317.
- Anand, R.J.D., March. More Data Usually Beats Better Algorithms. 2008, 24.
- Eadie, R.; Browne, M.; Odeyinka, H.; McKeown, C.; McNiff, S.J.A.i.c. BIM implementation throughout the UK construction project lifecycle: An analysis. Autom. Constr. 2013, 36, 145–151. [Google Scholar] [CrossRef]
- Insights, F.J.R.f.w.f.c.f. Betting on Big Data: How the right culture, strategy and investments can help you leapfrog the competition. 2015.
- Kaisler, S.; Armour, F.; Espinosa, J.A.; Money, W. Big data: Issues and challenges moving forward. In Proceedings of the 2013 46th Hawaii international conference on system sciences; 2013; pp. 995–1004. [Google Scholar]
- Wielki, J. Implementation of the big data concept in organizations-possibilities, impediments and challenges. In Proceedings of the 2013 Federated Conference on Computer Science and Information Systems; 2013; pp. 985–989. [Google Scholar]
- Osmani, M.; Glass, J.; Price, A. Architect and contractor attitudes to waste minimisation. In Proceedings of the Proceedings of the Institution of Civil Engineers-waste and resource management, 2006; pp. 65-72.
- Wang, L.; Leite, F. Knowledge discovery of spatial conflict resolution philosophies in BIM-enabled MEP design coordination using data mining techniques: a proof-of-concept. In Computing in Civil Engineering (2013); 2013; pp. 419-426.
- Jiao, Y.; Zhang, S.; Li, Y.; Wang, Y.; Yang, B.; Wang, L. An augmented MapReduce framework for building information modeling applications. In Proceedings of the Proceedings of the 2014 IEEE 18th International Conference on Computer Supported Cooperative Work in Design (CSCWD), 2014; pp. 283-288.
- Lin, J.R.; Hu, Z.Z.; Zhang, J.P.; Yu, F.Q.J.C.A.C.; Engineering, I. A natural-language-based approach to intelligent data retrieval and representation for cloud BIM. Comput. Civ. Infrastruct. Eng. 2016, 31, 18–33. [Google Scholar] [CrossRef]
- Dzuke, A.; Naude, M.J.J.J.o.T.; Management, S.C. Procurement challenges in the Zimbabwean public sector: A preliminary study. J. Transp. Supply Chain. Manag. 2015, 9, 1–9. [Google Scholar] [CrossRef]
- Hazra, J.; Mahadevan, B. A procurement model in an electronic market with coordination costs. In Proceedings of the 2011 IEEE International Conference on Industrial Engineering and Engineering Management; 2011; pp. 1364–1368. [Google Scholar]
- Mark McKevitt, D.; Davis, P.J.I.J.o.P.S.M. Supplier development and public procurement: allies, coaches and bedfellows. Int. J. Public Sect. Manag. 2014, 27, 550–563. [Google Scholar] [CrossRef]
- Leungbootnak, N.; Chaithongrat, T.; Aksorn, P. An exploratory factor analysis of government construction procurement problems. In Proceedings of the MATEC Web of Conferences, 2018; p. 02057.
- Tanayut, C.; Narong, L.; Preenithi, A.; Patrick, M. Application of Confirmatory Factor Analysis in Government Construction Procurement Problems in Thailand. Int. Trans. J. Eng. Manag. Appl. Sci. Technol. 2017, 8, 22. [Google Scholar]
- Du, J.; Jiao, Y.-Y.; Jiao, R.J.; Kumar, A.; Ma, M. A case study of obsolete part procurement process reengineering. In Proceedings of the 2007 IEEE International Conference on Industrial Engineering and Engineering Management; 2007; pp. 1337–1341. [Google Scholar]
- Burke, R. Project management: planning and control techniques; John Wiley & Sons: 2013.
- Chitkara, K. Construction Project Management-Planning, Scheduling and Controlling, Tata McGraw Hills. 2011.
- Maemura, Y.; Kim, E.; Ozawa, K. Root causes of recurring contractual conflicts in international construction projects: Five case studies from Vietnam. J. Constr. Eng. Manag. 2018, 144, 05018008. [Google Scholar] [CrossRef]
- Diekmann, J.E.; Kruppenbacher, T.A. Claims analysis and computer reasoning. J. Constr. Eng. Manag. 1984, 110, 391–408. [Google Scholar] [CrossRef]
- Kim, M.P. US Army Corps Engineers construction contract claims guidance system. In Proceedings of the Utilization of Ocean Waves—Wave to Energy Conversion; 1989; pp. 203–209. [Google Scholar]
- Chau, K.-W. Prediction of construction litigation outcome–a case-based reasoning approach. In Proceedings of the Advances in Applied Artificial Intelligence: 19th International Conference on Industrial, Engineering and Other Applications of Applied Intelligent Systems, IEA/AIE 2006, Annecy, France, June 27-30, 2006. Proceedings 19, 2006; pp. 548-553.
- Atuahene, B.T.; Kanjanabootra, S.; Gajendran, T. Transformative role of big data through enabling capability recognition in construction. Constr. Manag. Econ. 2023, 41, 208–231. [Google Scholar] [CrossRef]
- James, G.; Witten, D.; Hastie, T.; Tibshirani, R. An introduction to statistical learning; Springer: 2013; Volume 112.
- Breiman, L. Random Forests--Random Features. - 1999.
- Zhang, Z. Introduction to machine learning: k-nearest neighbors. Ann. Transl. Med. 2016, 4. [Google Scholar] [CrossRef] [PubMed]
- Canhoto, A.I.; Clear, F.J.B.H. Artificial intelligence and machine learning as business tools: A framework for diagnosing value destruction potential. Bus. Horiz. 2020, 63, 183–193. [Google Scholar] [CrossRef]
- Chen, J.H. KNN based knowledge-sharing model for severe change order disputes in construction. Autom. Constr. 2008, 17, 773–779. [Google Scholar] [CrossRef]
- Xie, S.; Fang, J. Prediction of construction cost index based on multi variable grey neural network model. Int. J. Inf. Syst. Change Manag. 2018, 10, 209–226. [Google Scholar] [CrossRef]
- Salama, D.M.; El-Gohary, N.M. Semantic text classification for supporting automated compliance checking in construction. J. Comput. Civ. Eng. 2016, 30, 04014106. [Google Scholar] [CrossRef]
- Elfahham, Y. Estimation and prediction of construction cost index using neural networks, time series, and regression. Alex. Eng. J. 2019, 58, 499–506. [Google Scholar] [CrossRef]
- Nguyen, P.T.; Nguyen, Q.L.H.T.T. Critical factors affecting construction price index: An integrated fuzzy logic and analytical hierarchy process. J. Asian Financ. Econ. Bus. 2020, 7, 197–204. [Google Scholar] [CrossRef]
- Lin, W.C.; Ke, S.W.; Tsai, C.F. Top 10 data mining techniques in business applications: a brief survey. Kybernetes 2017, 46, 1158–1170. [Google Scholar] [CrossRef]
- Cheng, M.Y.; Peng, H.S.; Wu, Y.W.; Chen, T.L. Estimate at completion for construction projects using evolutionary support vector machine inference model. Autom. Constr. 2010, 19, 619–629. [Google Scholar] [CrossRef]
- Cost, S.; Salzberg, S. A weighted nearest neighbor algorithm for learning with symbolic features. Mach. Learn. 1993, 10, 57–78. [Google Scholar] [CrossRef]
- Roy, R.; Low, M.; Waller, J. Documentation, standardization and improvement of the construction process in house building. Constr. Manag. Econ. 2005, 23, 57–67. [Google Scholar] [CrossRef]
- Kusonkhum, W.; Srinavin, K.; Leungbootnak, N.; Aksorn, P.; Chaitongrat, T. Government construction project budget prediction using machine learning. J. Adv. Inf. Technol. 2022, 13. [Google Scholar] [CrossRef]
- Wistuba, M.; Schilling, N.; Schmidt-Thieme, L. Hyperparameter optimization machines. In Proceedings of the 2016 IEEE International Conference on Data Science and Advanced Analytics (DSAA); 2016; pp. 41–50. [Google Scholar]
- Le, Q.V.; Ngiam, J.; Coates, A.; Lahiri, A.; Prochnow, B.; Ng, A.Y. On optimization methods for deep learning. In Proceedings of the Proceedings of the 28th International Conference on International Conference on Machine Learning, 2011; pp. 265-272.
- Wistuba, M.; Schilling, N.; Schmidt-Thieme, L. Learning hyperparameter optimization initializations. In Proceedings of the 2015 IEEE international conference on data science and advanced analytics (DSAA), 2015; pp. 1-10.
- Hazan, E.; Klivans, A.; Yuan, Y.J.a.p.a. Hyperparameter optimization: A spectral approach. 2017.
- Hernández-Torruco, J.; Canul-Reich, J.; Frausto-Solis, J.; Méndez-Castillo, J.J. Towards a predictive model for Guillain-Barré syndrome. In Proceedings of the 2015 37th Annual International Conference of the IEEE Engineering in Medicine and Biology Society (EMBC); 2015; pp. 7234–7237. [Google Scholar]
- Allen, K.; Berry, M.M.; Luehrs, F.U., Jr.; Perry, J.W.J.A.D. Machine literature searching VIII. Operational criteria for designing information retrieval systems. Am. Doc. 1955, 6, 93. [Google Scholar]
- Gondia, A.; Siam, A.; El-Dakhakhni, W.; Nassar, A.H. Machine learning algorithms for construction projects delay risk prediction. J. Constr. Eng. Manag. 2020, 146, 04019085. [Google Scholar] [CrossRef]
- Suntharanurak, S. Screening for bid rigging in rural road procurement of Thailand. Doctoral dissertation, National Institute of Development Administration, 2012.
- Samui, P.; Roy, S.S.; Balas, V.E. Handbook of neural computation; Academic Press: 2017.
- Lu, B.; Hardin, J. Constructing prediction intervals for random forests. Ph. D. thesis, Pomona College, 2017.
- Tang, L.; Zhao, Y.; Cabrera, J.; Ma, J.; Tsui, K. L. Forecasting short-term passenger flow: An empirical study on shenzhen metro. IEEE Trans. Intell. Transp. Syst. 2018, 20, 3613–3622. [Google Scholar] [CrossRef]
- Bergstra, J.; Bengio, Y. Random search for hyper-parameter optimization. J. Mach. Learn. Res. 2012, 13. [Google Scholar]
- Bergstra, J.; Bardenet, R.; Bengio, Y.; Kégl, B. Algorithms for hyper-parameter optimization. Adv. Neural Inf. Process. Syst. 2011, 24. [Google Scholar]
- Bergstra, J.; Yamins, D.; Cox, D. Making a science of model search: Hyperparameter optimization in hundreds of dimensions for vision architectures. In Proceedings of the International conference on machine learning; 2013; pp. 115–123. [Google Scholar]
- Olson, D.L.; Delen, D. Advanced data mining techniques; Springer Science & Business Media: 2008.
|
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content. |
© 2023 by the authors. Licensee MDPI, Basel, Switzerland. This article is an open access article distributed under the terms and conditions of the Creative Commons Attribution (CC BY) license (http://creativecommons.org/licenses/by/4.0/).
