Preprint
Article

This version is not peer-reviewed.

Enhancing Railway Track Intervention Planning: Accounting for Component Interactions and Evolving Failure Risks

A peer-reviewed article of this preprint also exists.

Submitted:

26 January 2025

Posted:

04 February 2025

Read the latest preprint version here

Abstract

This manuscript proposes a methodology to leverage digitalisation to efficiently generate an overview of required condition-based railway track interventions, possession windows, and expected costs for railway networks at the beginning of the intervention planning process. The consistent and efficient generation of such an overview not only helps track managers in their decision-making, but also facilitates the discussion among other decision-makers in later phases of the track intervention planning process, including line planners, capacity managers, and project managers. The methodology uses data of different levels of detail, discrete state modelling for uncertain deterioration of components, and component-level intervention strategies. It dynamically updates the condition estimates of components by capturing the interaction between deteriorating components using Bayesian filters. It also estimates the risks associated with different types of potential service losses that may occur due to sudden events using fault trees as a function of time and the condition of components. An implementation of the methodology is done for a 25 km regional railway network in Switzerland. The results suggest that the methodology has the potential to help track managers early in the intervention planning process. In addition, it is argued that the methodology will lead to improvements in the efficiency of the planning process, improvements in the scheduling of preventive interventions, and the reduction in corrective intervention costs upon the implementation in a digital environment.

Keywords:
;  ;  ;  ;  ;

1. Introduction

Track managers currently estimate intervention requirements qualitatively in the initial phases of the intervention planning process, based on the synthesis of visual inspection results by a group of track engineers. The current practice, however, is time-consuming, labour-intensive, and cognitively demanding for engineers. Moreover, the biases and subjectivity of experts’ judgments may result in the sub-optimal scheduling of interventions. This could eventually result in higher intervention costs and more frequent service disruptions. Consequently, a systematic approach that can generate a quantitative and comprehensive outlook of intervention requirements for all tracks over the future planning periods, considering all crucial factors and criteria, would be beneficial for track managers.
The current intervention planning process can be improved through the integration of a digital tool, leveraging recent technological advancement and the accumulation of extensive data on track component characteristics, their condition, the evolution of their condition over time, and the costs associated with their maintenance and replacement. This tool can improve the ability of track managers to plan effectively [1,2].
This manuscript proposes a methodology to automatically generate a consistent overview of component-level interventions, costs, possession windows, and the evolution of failure risks for all track sections located in a railway network over future planning periods. This includes considering the interaction between deteriorating components using Bayesian filters, the impacts of the residual damages to the components due to imperfect execution of maintenance interventions using non-homogeneous transition probabilities, and the evolving risks associated with different types of potential service losses that may occur due to sudden and gradual deterioration events connected to the time and the condition of components using fault trees. The methodology uses data of different levels of detail, probabilistic discrete state modelling for uncertain deterioration of components, and component-level intervention strategies.
The methodology enables the use of both qualitative and quantitative data collected from several sources such as visual inspections, approximate and detailed estimates of failure risks, intervention costs and impacts on service. An application of this methodology is demonstrated by estimating a complete overview of component-level intervention requirements for track sections on a 25 km railway network in Switzerland.
The remainder of this manuscript is organised as follows. Section 2 provides a brief overview of the research on estimating the intervention requirements for railway assets. Section 3 includes a detailed description of the proposed methodology. Section 4 includes a detailed explanation of the example railway network along with a detailed description of results from the implementation of the proposed methodology. Section 5 explains how to enable the use of the methodology in infrastructure management firms. Finally, the manuscript is concluded in Section 7.

2. Literature Review

State-of-the-art methodologies aim to improve intervention planning for different infrastructure assets by addressing the concerns of different asset managers. A selection of these methodologies are summarised in Table 1 and Table 2. These methodologies are based on either deterministic or probabilistic modelling approaches.
Deterministic models mainly assume the condition of a railway asset evolves over time as a (non-)linear function of the asset age. For example, Giunta et al. [3] developed maintenance strategies for the bitumen-stabilised ballast using a deterministic model as a function of the age of the ballasts. While these models ensure the ease of comprehension and implementation in the existing asset management systems, they do not account for the uncertain behaviour of railway assets throughout their life cycle [4].
Probabilistic models, on the other hand, consider the uncertainties associated with the evolution of railway assets’ condition subject to several deterioration processes over time. For example, Fecarotti and Andrews [5], followed by Fecarotti, Andrews, and Pesenti [6] determined the optimal track intervention strategies with the help of probabilistic modelling of deterioration processes to account for the uncertain evolution of track assets throughout their life cycle.
In addition, many state-of-the-practice methodologies use probabilistic modelling; for example, AASHTOWare in USA, Kuba and SwissTamp in Switzerland, and the Network Rail bridge-management system in the UK [7,8,9]. These systems estimate intervention requirements over future planning periods by classifying the damage indicator measurements, determined by the inspectors, into appropriate Condition States (CSs) and probabilistically modelling their evolution over time.
Although these methodologies can be used to generate an overview of intervention requirements, they often lack the detail and considerations required by track managers such as service loss risks, and the granularity of intervention estimates. To address this limitation, some researchers suggested incorporating the sudden deterioration processes, such as the occurrence of natural hazards into the probabilistic methodologies. For example, Lethanh et al. [10] developed a Markov model for determining optimal intervention strategies taking into account both gradual and sudden deterioration processes using two sets of non-failure and failure CSs. Similarly, Kobayashi et al. [11] used Bayesian estimation and Markov Chain Monte Carlo method to estimate how assets evolve over time. These work, however, did not consider the interaction between deteriorating asset components. Therefore, some researchers proposed to consider such interaction in the construction of the models. For example, Fecarotti and Andrews [12] incorporated the risks associated with railway track failure into their probabilistic modelling to determine the optimal track intervention strategy. Although not explicitly, they considered the interaction between deteriorating railway assets. In addition, others suggested considering the dynamic changes in the deterioration modelling to account for the impact of the residual damages after the execution of maintenance interventions. For example, Mehranfar et al. [13] incorporated the dynamic changes in the deterioration rate of each asset component after each maintenance intervention into their probabilistic deterioration modelling to have more realistic estimates of intervention requirements using non-homogeneous transition probabilities. Some suggested conducting the deterioration modelling at the element level instead of the component level, meaning that the analysis is to be done for each element such as each bolt in a fastening system. For example, Kaewunruen et al. [14] proposed a risk-based intervention planning methodology for fastening systems. This level of detail, however, require a vast amount of high quality data and computing capacity.
Unfortunately, these cutting-edge methodologies are not often deemed desirable by track managers, despite their potential benefits. There are two major reasons for this. First, the implementation of these methodologies increases the efforts needed by track managers and the inspectors to generate an early-phase overview of track interventions. This is considered by many as a major barrier, e.g., collection and analysing element-level data on all track sections requires significant amount of time and effort since a detailed study must be conducted on all track sections in a network. Second, from the management point of view, it is more likely that an intervention is executed on all components of the same type in a track section, rather than targeting only a single element in that track section. Indeed, the likelihood might not be the same based on the specific characteristics of the components.
Ultimately, this manuscript presents a methodology to generate an efficient and complete overview of intervention requirements, their possession windows, and costs. It contributes to the state-of-the-art by:
  • estimating intervention requirements and the failure risk at the component level, since this is considered to establish an appropriate trade-off between the required effort to implement the methodology and provided level of detail.
  • using non-homogeneous deterioration rates coupled with Bayesian filters to provide an improved modelling of the components’ deterioration, since the deterioration rate of the components changes over time due to both the imperfections in the execution of the maintenance intervention and the interaction between deteriorating components [15]. For example, a fresh ballast does not behave the same as a ballast that has been rehabilitated three times.
  • incorporating the service loss in the estimation of intervention requirements in addition to the structural failure since the highest risks associated with railway tracks in a well-managed railway infrastructure is the service loss, and not total structural failure.
Table 1. Summary of a selection of literature related to railway intervention estimation.
Table 1. Summary of a selection of literature related to railway intervention estimation.
Source Theme Detail Level
Adey and Hajdin[16] Methodology for determination of financial needs of gradually deteriorating bridges with only structure level data Asset
Allah Bukhsh et al.[17] Multi-year maintenance planning framework using multi-attribute utility theory and genetic algorithms Asset
Bressi et al.[18] Optimization of maintenance strategies for railway track-bed considering probabilistic degradation models and different reliability levels Element
Chiachío et al.[19] A knowledge-based prognostics framework for railway track geometry degradation Asset
Consilvio et al.[20] A data-driven prioritisation framework to mitigate maintenance impact on passengers during metro line operation Asset
Consilvio et al. On Applying Machine Learning and Simulative Approaches to Railway Asset Management: The Earthworks and Track Circuits Case Studies Asset
Fecarotti and Andrews[21] A Petri net approach to assess the effects of railway maintenance on track availability Component
Fecarotti and Andrews[12] Producing effective maintenance strategies to control railway risk Asset
Giunta et al.[3] Life cycle cost assessment of bitumen stabilised ballast: A novel maintenance strategy for railway track-bed Element
Hidirov and Guler[22] Reliability, availability and maintainability analyses for railway infrastructure management Component
Irfan et al.[23] Framework for airfield pavements management—an approach based on cost-effectiveness analysis Asset
Kaewunruen et al.[14] Risk-Based Maintenance Planning for Rail Fastening Systems Element
Kobayashi et al.[11] A competing Markov model for cracking prediction on civil structures Asset
Le et al.[24] A Petri net model for railway bridge maintenance Asset
Mehranfar et al.[13] Automated early estimation of bridge interventions, possession windows and costs Component
Papathanasiou and Adey[25] Making comparable risk estimates for railway assets of different types Asset
Prescott and Andrews[26] Investigating railway track asset management using a Markov analysis Asset
Prescott and Andrews[27] A track ballast maintenance and inspection model for a rail network Component
Rúa et al.[28] A top-down approach for a multi-scale identification of risk areas in infrastructures: particularization in a case study on road safety Asset
Sadeghi et al.[29] Improvement of railway ballast maintenance approach, incorporating ballast geometry and fouling conditions Element
Sancho et al.[30] Optimizing Maintenance Decision in Rails: A Markov Decision Process Approach Asset
Sasidharan et al.[31] A whole life cycle approach under uncertainty for economically justifiable ballasted railway track maintenance Asset
Sharma et al.[32] Data-driven optimization of railway maintenance for track geometry Asset
Soleimanmeigouni et al.[33] Prediction of railway track geometry defects: a case study Asset
Sresakoolchai and Kaewunruen[34] Railway infrastructure maintenance efficiency improvement using deep reinforcement learning integrated with digital twin based on track geometry and component defects Component
Usman et al.[35] Railway track subgrade failure mechanisms using a fault chart approach Element
Usman et al.[36] Using Probabilistic Fault Tree Analysis and Monte Carlo Simulation to Examine the Likelihood of Risks Associated with Ballasted Railway Drainage Failure Asset
Vale and Simos[37] Prediction of Railway Track Condition for Preventive Maintenance by Using a Data-Driven Approach Asset
Vandoorne and Gräbe[38] Stochastic rail life cycle cost maintenance modelling using Monte Carlo simulation Element
Wenfi et al.[39] Optimization Model of Life Cycle Repair Decisions for Track Network Asset
This manuscript Improving the intervention planning of railway tracks considering the interaction of components and uncertain evolution of failure risks Component
Table 2. Summary of a selection of literature related to railway intervention estimation.
Table 2. Summary of a selection of literature related to railway intervention estimation.
Deterioration Types Failure Risks
Source Gradual Sudden Deterioration Modelling Dynamic Deterioration Rates Interaction Between Assets/Components Structural Service Dynamic FR[1] Calculation IS[1] determination/Utilization Generating Future Interventions Overview
Adey and Hajdin[16] Stochastic × × × × ×
Allah Bukhsh et al.[17] × Mixed × × × ×
Bressi et al.[18] × Stochastic × × × × × ×
Chiachío et al.[19] Stochastic × × × × ×
Consilvio et al.[20] × × - × × × × ×
Consilvio et al. × Stochastic × × × ×
Fecarotti and Andrews[21] Stochastic × × × × ×
Fecarotti and Andrews[12] Stochastic × × × × ×
Giunta et al.[3] × Deterministic × × × × × ×
Hidirov and Guler[22] Stochastic × × × × ×
Irfan et al.[23] × Deterministic × × × × × ×
Kaewunruen et al.[14] × Stochastic × × × × ×
Kobayashi et al.[11] × Stochastic × × × × ×
Le et al.[24] × Stochastic × × × × × ×
Mehranfar et al.[13] Stochastic × ×
Papathanasiou and Adey[25] × - × × × × ×
Prescott and Andrews[26] × Stochastic × × × × × ×
Prescott and Andrews[27] × Stochastic × × × × × ×
Rúa et al.[28] × - × × × × × ×
Sadeghi et al.[29] × Deterministic × × × × × ×
Sancho et al.[30] × Stochastic × × × × × ×
Sasidharan et al.[31] Stochastic × × × × ×
Sharma et al.[32] Stochastic × × × × ×
Soleimanmeigouni et al.[33] × Deterministic × × × ×
Sresakoolchai and Kaewunruen[34] × AI × × × × ×
Usman et al.[35] × - × × × × × ×
Usman et al.[36] × Stochastic × × × × ×
Vale and Simos[37] × Stochastic × × × × × ×
Vandoorne and Gräbe[38] Stochastic × × × × ×
Wenfi et al.[39] Stochastic × × × ×
This manuscript Stochastic

3. Methodology

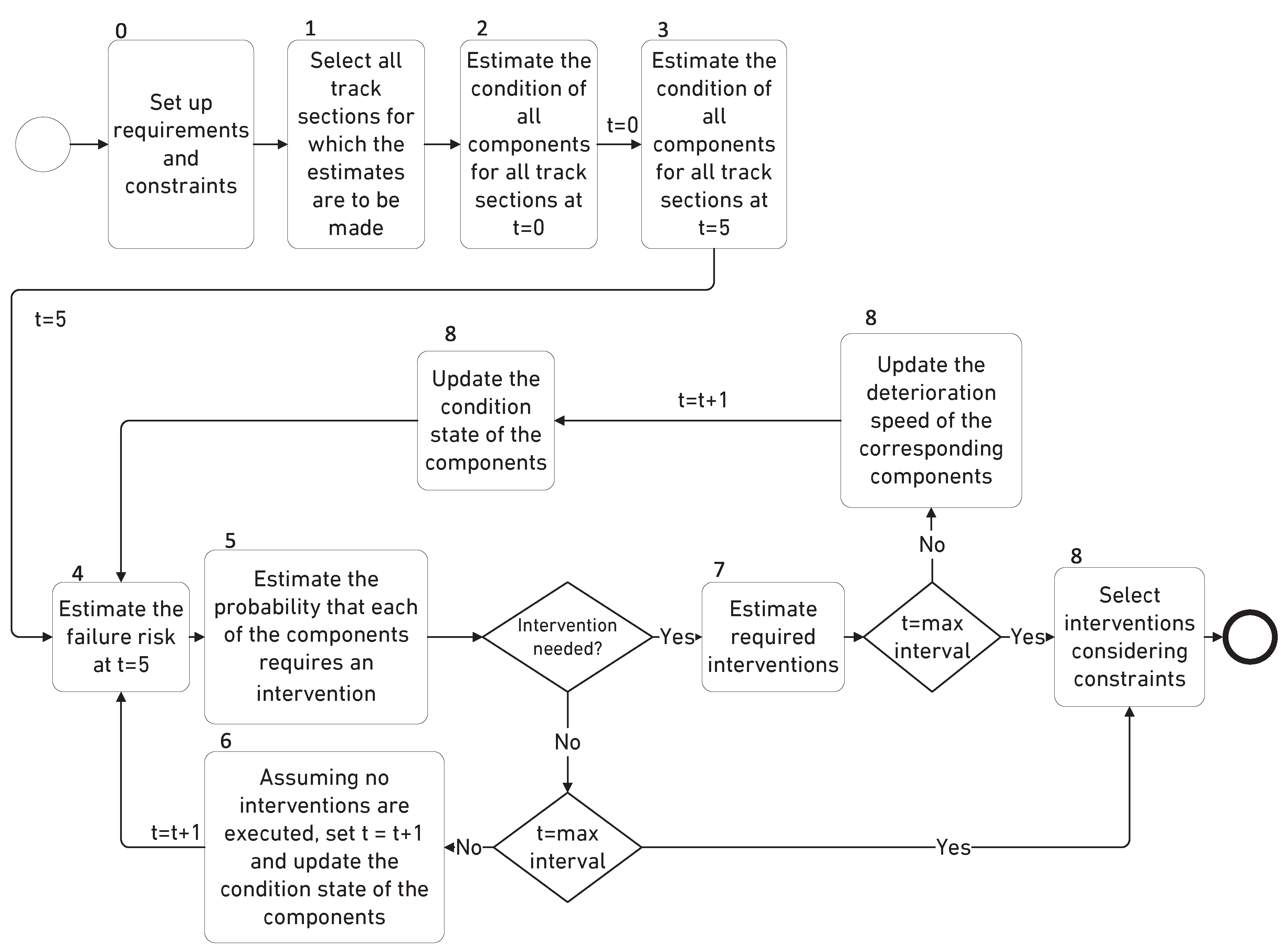

3.1. Steps

The overview of the proposed methodology is shown in Figure 1. This methodology encompasses multiple steps that are described as follows:
0.
Set up the requirements and constraints: the requirements and constraints for initialising and using the algorithm must be set up first.
1.
Select all track sections for which the estimates are to be made: the track sections that are planned to perform a detailed investigation by engineering firms must be excluded.
2.
Estimate the condition of all components for all track sections at t = 0 : the initial condition of all track components should be consistently estimated.
3.
Estimate the condition of all components for all track sections at t = 5 : based on the practice, the 15 years planning horizon is divided into the blocks of five years, wherein, all interventions between t = 0 and t = 5 have already been planned and almost no major changes can be made. Therefore, the beginning of the planning period is t = 5 .
4.
Estimate the failure risk at t = 5 : the risks associated with the occurrence of the different service loss types need to be estimated.
5.
Estimate the probability that each component requires an intervention based on component-level intervention strategies: these estimates are done for the periods between t = 6 and t = 10 and between t = 11 and t = 15 .
6.
If no intervention is needed, set t = t + 1 and update the condition state of the components: repeat steps 3 to 6 until the probabilities of components requiring intervention and the failure risks have been estimated for each of the five years within each planning period.
7.
Estimate the required interventions: an intervention on a track section in the upcoming planning period is required if either the probability of requiring intervention on any of its components or the failure risk in that planning period exceeds a certain threshold value. The possible and most likely types of interventions, required possession windows, and intervention costs are estimated as a function of the intervention type and service impacts.
8.
Suggest intervention postponements: prioritize interventions based on the failure risk value if the execution of all of them is not possible within the planning period. Then, postpone the interventions associated with the lower-risk track sections until the constraints are met.

3.2. Requirements and Constraints

The requirements and constraints for initialising and using the algorithm are:
  • Definition of track components: the main track components are discerned through examination of the track drawings. Subdividing the tracks into components helps provide more insight into the content of future intervention requirements. For example, knowing that the switches of a track section will require a rehabilitation intervention in 10 years and that this will require the closing of the associated track for eight hours is more useful than just knowing that the track section will require a rehabilitation intervention and being unsure if the intervention can be executed with or without closing the rail line. In addition, this allows early estimations of the costs and the possibility of executing multiple interventions simultaneously on different components of the track section. A more detailed analysis would subdivide the track sections into their elements. For example, each switch associated with a track section consists of the switching machine, toes, switch rails, fastenings, ballasts, sleepers, heels, check rail, wing rail, crossing nose, stock rail, through rail, and subgrade [40]. This is, however, not currently proposed for two reasons. First, it would increase the work required by track managers and inspectors to obtain the initial overview of the track sections, which is a major barrier to implementation. Second, it is unlikely that interventions would target single elements, and it is more likely that multiple elements of a single component would need intervention. For instance, it is more plausible for an intervention to be executed on all fastenings in a track section simultaneously, rather than targeting a single fastening element. Therefore, estimating the required interventions on the component level provides a suitable balance between the accuracy and the required time and effort in estimating the information to make estimates for all track sections in a network.
  • Definition of possible condition states of track components: the condition states are defined to reflect the physical condition of the components. Different classification schemes can be used for this purpose, such as a discrete scale between 1 to 5 that is used in this manuscript to classify the condition of components. In this classification scheme, the best condition is represented by Condition State 1 (CS1) and the worst condition is represented by Condition State 5 (CS5). These definitions have to comply with the organization’s guidelines and preferences of track managers.
  • Estimation of the current condition state of components: the current CS of components is estimated using existing data sources, e.g., proprietary asset condition database. If they are not explicitly estimated, the inspection reports can be used to determine the CS of the components by matching the damage indicators mentioned in the inspection reports with the definition of the CSs. In case the existing data is imperfect or if data on the condition of the components is not available, different methods such as Bayesian networks can be used to estimate the current condition of components [41].
  • Estimation of the likelihood of changing states over time, i.e., transition probabilities: Estimating transition probabilities is necessary to predict the future state of components. In the absence of the condition monitoring data, these values can be estimated using expert opinion taking into account the interaction between deteriorating components and the impacts of the residual damages to the component due to imperfect execution of maintenance interventions. These values can be updated once enough information becomes available, for example, using data-driven approaches [42,43].
  • Definition of possible interventions for each track component in each CS and estimation of their costs and impacts on service: the possible interventions associated with each CS for each component should include the activities to address the damage indicators mentioned in the definition of the CSs, along with the estimates of their costs and impacts on service. For example, a switch should be replaced if signs of plastic deformation are observed in the crossing nose of the switch, i.e., CS5. This intervention roughly costs 0.5 million Monetary Units (0.5Mum) and approximately takes 8 hours to complete. These interventions and estimates can be defined using expert opinion or using existing references, e.g., [44].
  • Identification of the best component-level intervention strategies: these strategies provide a guideline as to the actions to be taken when a component is in a specific CS. For example, the intervention strategy for the switches could indicate that no intervention needs to be executed on the switches if they are in CS 1-4, and a replacement is needed if they are in CS5.
  • Definition of fault trees for the track sections: fault trees can assess how each component functions individually and how they work together to ensure the provision of sufficient service on the track section. These are used to approximate the probability of a track section not providing the expected service (failure) when the components are in different CSs. These fault trees can be developed initially with an acceptable level of detail and then be updated with more sophisticated ones based on the requirements of track managers.
  • Estimation of the occurrence probability of basic events: the probability of occurrence for a basic event should be correlated to the time and the evolution of components’ CS, which is likely to provide a realistic idea of how the failure risks evolve over time. For example, if a switch is in CS1, the failure probability of this switch due to the occurrence of a sever sudden event is very low ( 10 · e 5 ), whereas this probability is very high ( 10 · e 3 ) if the switch is in CS5. These estimations can initially be made using expert opinion and then be updated in the future using more advanced approaches such as Finite Element Analysis done by [45,46].
  • Estimation of the consequences of each failure type: the consequences related to the occurrence of each failure type, i.e., the top events, must be estimated to enable calculation of the failure risks that are dependent on the time and condition of components. For example, the estimation of consequences must encompass owner and user costs, which include expenses related to materials and equipment, traffic management, and increased travel time due to the service reduction or loss. These estimations can be made using a combination of expert opinion and construction price indices, e.g., Swiss construction pricing index [47].

4. Case Study

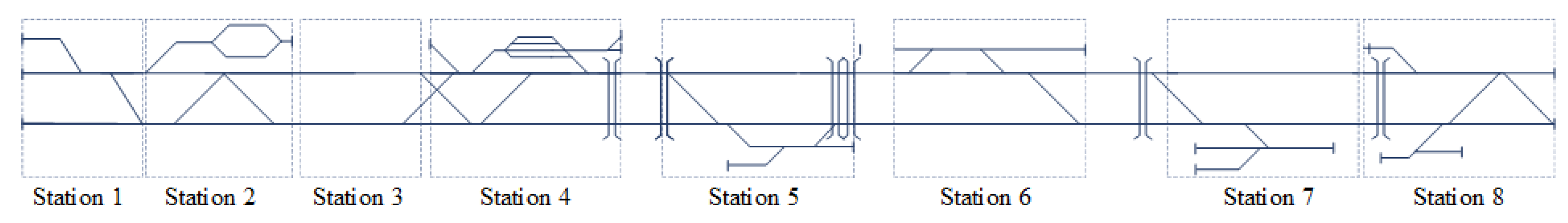

The case study includes a network of eight stations spanning a distance of 25km located in Switzerland. A schematic overview of the case study is shown in Figure 2. This is a double-track network with an average daily passenger traffic of 45 trains on each track side. The geometry of tracks is measured using diagnostics trains twice a month for twist, cross-level, gauge, curvature, and alignment error [48]. In addition, other possible issues such as sleeper cracks or ballast loss are measured every year on the tracks with high demand using semi-automatic and manual inspections [49,50].
The case study is segmented into 154 tracks and 161 switches considering the length of 120-125 for each track section. The latest inspection reports regarding the condition of each track section are available in the internal track condition database. A summary of the condition of all track sections is provided in Figure 3. It is observed that while most switches are in a rather healthy condition, tracks are mostly in a damaged condition.

4.1. Components

Railway tracks are split into five main components, i.e., rails, fastenings, sleepers, ballasts/sub-ballasts, and subgrades, as illustrated in Figure 4. Ballasts and sub-ballasts are considered as one component since they deteriorate in a similar manner [44]. In addition, switches are considered as one component since their maintenance includes performing interventions on multiple elements [44,51].

4.2. CS of the Components at t = 0 and t = 5

The condition of the components is represented through five discrete states, i,e., C S = [ 1 2 3 4 5 ] . In this scale, CS1 represents the best condition where there is no or minor damage and CS5 represents the worst condition, where there exists severe damage that is unsafe. The states in between show increasing levels of damage. Table 3 shows an example definition for the CSs of the switches. Based on this table, switches are in CS1 if they have no issues, and in CS5 if the settlement is too high, or the cross nose is deformed. Similar to switches, such CSs are defined for other components. The CSs are defined for all other track components similarly. These definitions can also be updated over time to include the results of more detailed methods, e.g., ultrasonic measurements for corrosion penetration into switchblades.

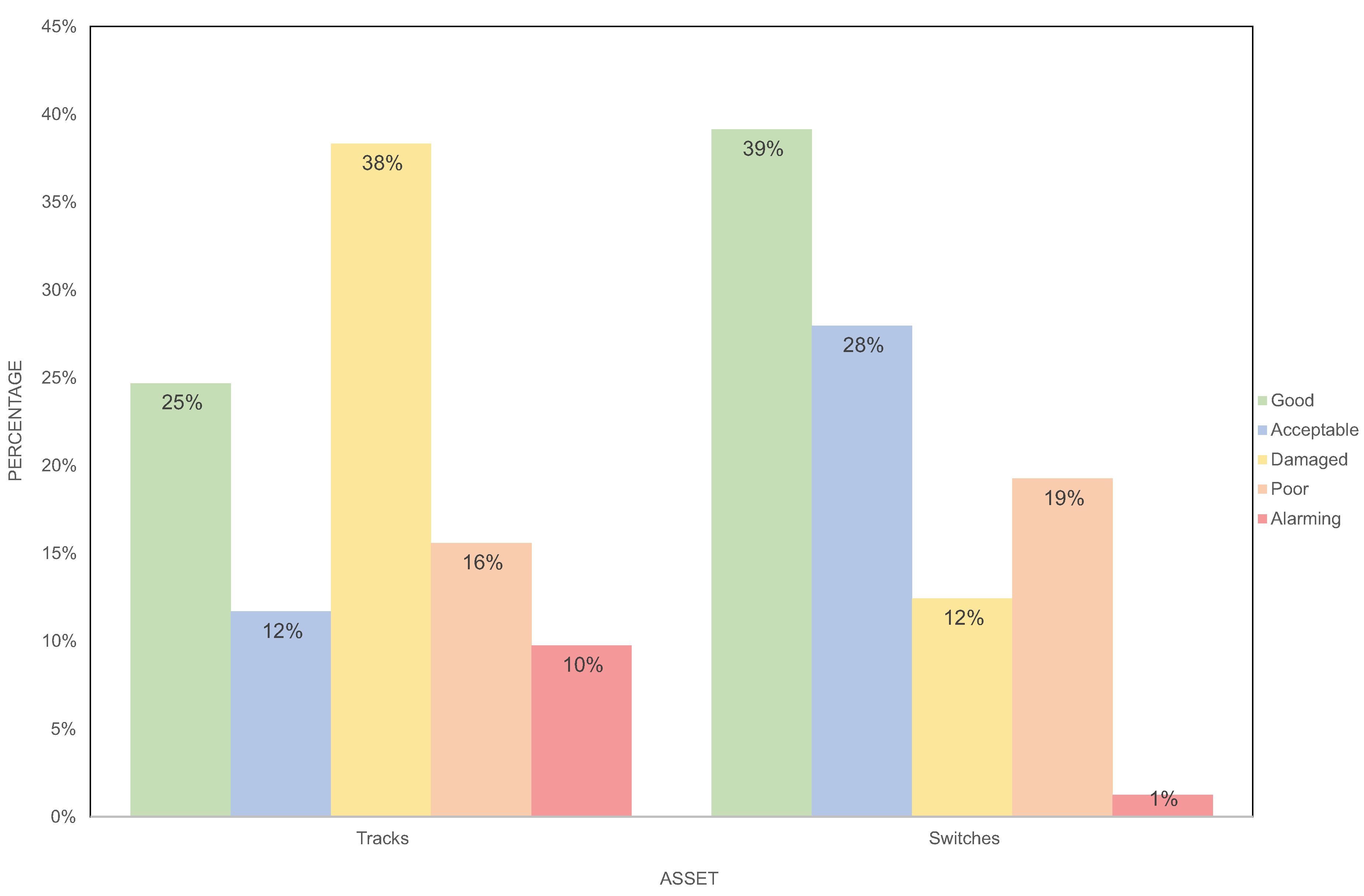

The CS of all track components at t = 0 is estimated based on information provided in the latest inspection reports, which is summarized in Figure 5a. The CS of components in each track section is assumed to be the same as the overall CS of that track section, for those track sections where component-level information was not available. This assumption allows consistent estimation of initial CSs across all components, ensuring a convenient approach in the absence of component-level information.
Probabilistic discrete state modelling is used to estimate how CSs evolve over time, which is similar to the modelling used in existing railway asset management systems [30,32]. Table 4 represents an example of non-homogeneous transition probabilities for switches over a one-year period, which corresponds to the mean interval between two inspections. Here, it is assumed deterioration rates increase as a function of the times maintenance interventions are executed on the component. This is because of imperfection in executing maintenance interventions, which do not always reinstate the physical and chemical characteristics of the components[16]. The impact of this on the deterioration rate can be determined using expert opinion. In case enough data is available other methods such as stochastic approaches can be used to determine this impact [52,53]. It is assumed there is a 2 % increase in the deterioration rate following each successive maintenance intervention. This assumption is inspired by the works of Peng et al. and Li an Jia [54,55]. The maintenance count resets for each component upon the replacement of the component. This rationale is consistently applied across all components.
Moreover, the deterioration rates for each component are further refined to account for the interaction between deteriorating components. Bayesian filters are used for this purpose. These are defined depending on the location of the components on the tracks. For example, while the condition of the rails is influenced by the condition of the fastenings, sleepers, ballasts, and subgrade, the condition of the subgrade and switches is independent of the condition of other components [21,44]. For example, Equation 1 represents the Bayesian filter associated with the interaction between rails and other track components, which is indicated with Γ R a i l s . In this equation, Γ R a i l s = I I i s a n i d e n t i t y m a t r i x . when other influencing components are in CS1 or CS2. The influence of the condition of other components, when they are in CS3, CS4, and CS5 on the CS of the rails are represented respectively by α , β , and η . The values associated with these filters can be estimated using expert opinion or using more advanced techniques, such as regression-based nonlinear optimisation or neural networks [56,57] in case enough information is available. Here it is assumed that α = 0.0001 , β = 0.0005 , and η = 0.001 . These values are inspired by the works of Chen et al., Niroshan et al., and Kobayashi et al. [11,56,57].
Γ R a i l s = I if C S F a s t e n i n g s = { 1 , 2 } | C S S l e e p e r s = { 1 , 2 } | C S B a l l a s t s = { 1 , 2 } | C S S u b g r a d e s = { 1 , 2 } I i i α i { 1 , 2 , 3 , 4 } if C S F a s t e n i n g s = { 3 } | C S S l e e p e r s = { 3 } I i ( i + 1 ) + α i { 1 , 2 , 3 , 4 } | C S B a l l a s t s = { 3 } | C S S u b g r a d e s = { 3 } I i i β i { 1 , 2 , 3 , 4 } if C S F a s t e n i n g s = { 4 } | C S S l e e p e r s = { 4 } I i ( i + 1 ) + β i { 1 , 2 , 3 , 4 } | C S B a l l a s t s = { 4 } | C S S u b g r a d e s = { 4 } I i i η i { 1 , 2 , 3 , 4 } if C S F a s t e n i n g s = { 5 } | C S S l e e p e r s = { 5 } I i ( i + 1 ) + η i { 1 , 2 , 3 , 4 } | C S B a l l a s t s = { 5 } | C S S u b g r a d e s = { 5 }

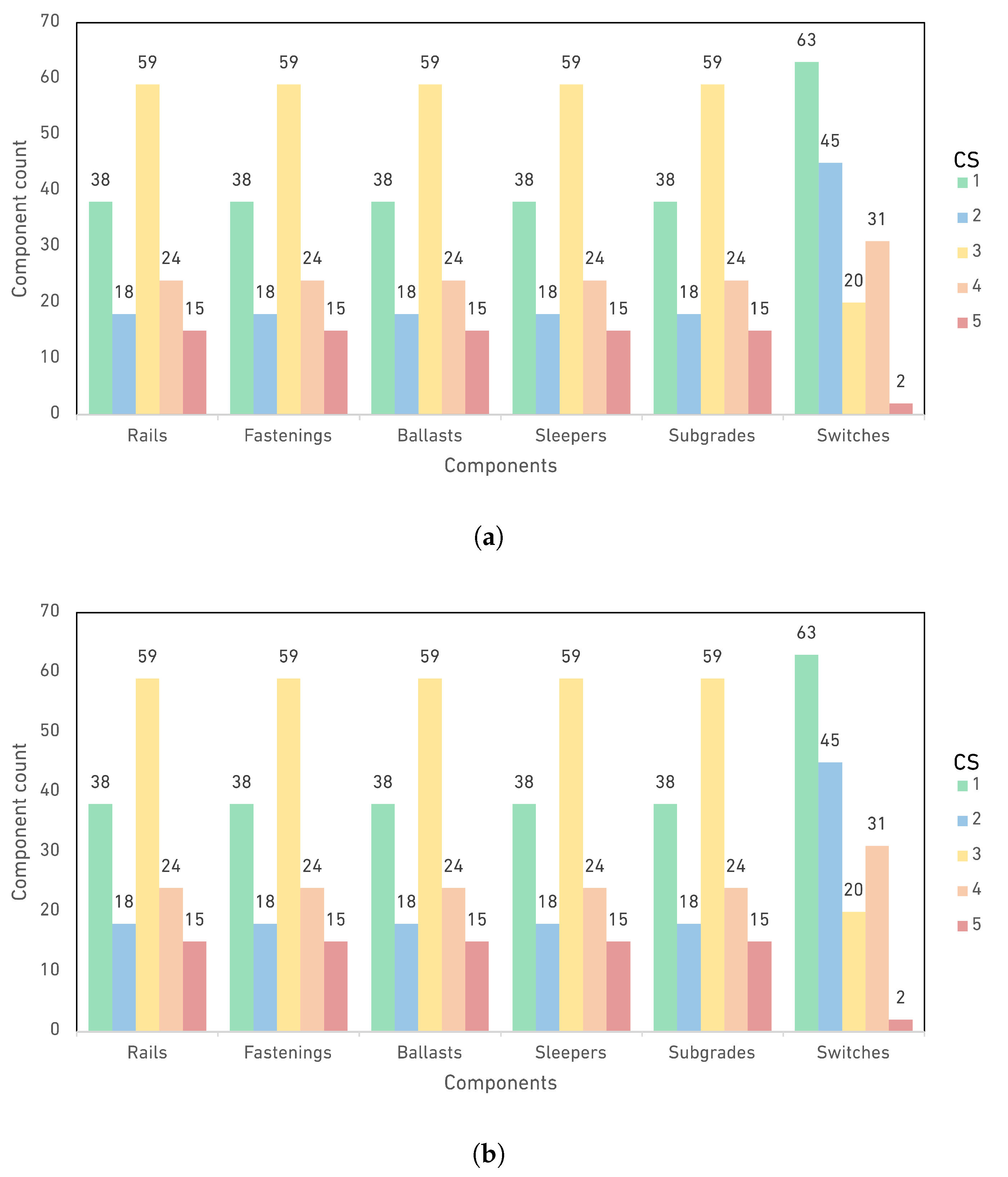

An overview of the most likely CS of all components at t = 5 is shown in Figure 5b. These are estimated using Equation 2 that multiplies the CS of components at t = 0 with the probability of them transitioning to the possible future states, shown with P, and with the Bayesian filter associated with each component, represented by Γ , within 5 years.
C S t + 1 = C S t · P · Γ

4.3. Component-Level Interventions and Intervention Strategies

Several interventions are required to maintain the expected serviceability of components throughout their life cycle. These interventions vary with respect to the component characteristics and damage severity. These interventions can be categorised using three generic terms, i.e., Rehabilitation, Renewal, and Replacement to represent different levels of execution complexity [16,44].
The intervention costs are calculated as the total of owner costs, C O , and user costs, C U , C T o t a l = C O + C U . C O is calculated using a construction pricing index [47]. C U is calculated by monetizing the average daily added travel time, i.e., 6’524 mu/day, using Equation 3. In this formula, the average number of passengers per day is represented by A P D , average daily wage by A D W , and average daily added travel time per passenger by A T P .
C U = A P D × A D W × A T P
Table 5 shows example switch intervention costs, which increase with the complexity and labour demand of activities[58]. These costs are calculated similarly for other track components.
Component-level intervention strategies along with their effectiveness can be estimated using a combination of the internal documentation and expert opinion. In case these strategies do not exist in an organisation, they can be determined using different techniques such as Markov chains [13,16]. For example, Table 6 shows an example of multiple variants for switch intervention effectiveness, where the switch intervention strategy used is highlighted in violet, and the effectiveness is given in terms of probability of being in CS1 or CS2 after the execution of the intervention. This is derived using internal documents of railway assets. The switch intervention strategy indicates no intervention is needed in CS1 and CS2, while a replacement is needed in CS5. For CS3 and CS4, rehabilitation and renewal are applied, respectively. The effectiveness indicates the probability of a component being in CS1 or CS2 after executing an intervention, which can be estimated with different methods for example using Data Envelopment Analysis [59,60]. In this paper, these are inspired by the values mentioned in [58,59,60].

4.4. Evolution of Failure Risks

The evolution of failure risks is estimated using fault trees, connected to the components’ failure severity. Top events are "restricted service" ( due to rehabilitation at night) and "interrupted service" (due to replacement with total closure) defined for each track section, as shown in Figure 6a and Figure 6b, respectively. The basic events are gradual or sudden deterioration of the individual components due to external loads, such as traffic or natural hazards.
Failure probabilities of components are estimated based on the occurrence probability of basic events. These events depend on the occurrence of external loads and the component resistance. The occurrence of external loads is independent of CSs of components and based on expert opinion, while the resistance of components varies with components’ CS. This means the failure probabilities of components due to the occurrence of basic events vary for different CSs at different times, with a lower value for CS1 and a higher value for CS5.
Equation 4 indicates how failure probabilities are estimated, where P o F i j t represents the probability that component i fails at year t due to the occurrence of the sudden event j, P o S j t is the occurrence probability of the sudden events j until year t, R f i is the resistance factor of component i, and C S i t is the CS of the component i at year t, which is represented as a 1 × 5 vector. P o S j t is assumed to follow a Poisson process as suggested by Usman et al.[36]. This way of calculating the failure probabilities enables taking into account the changes in the occurrence probability of top events in each year within each planning period.
P o F i j t = P o S j t · R f i · C S i t i Components & j Sudden events
For example P o F of a switch at year t due to the occurrence of the sudden event j with a return period of T years, i.e., λ j = 1 T at year t and the resistance vector R f S w i t c h = [ R f S w i t c h C S 1 R f S w i t c h C S 2 R f S w i t c h C S 3 R f S w i t c h C S 4 R f S w i t c h C S 5 ] can be calculated as:
P o F S w i t c h , j t = ( ( λ j · t ) 1 · e λ j · t 1 ! ) × R f S w i t c h × C S S w i t c h t
The consequences of each top event depend on how much work is needed to restore the level of service. These are estimated in terms of owner and user costs of executing immediate interventions using information from Section 4.3. The failure risks associated with each track section are then estimated depending on the components’ CS. These estimates enable obtaining a meaningful overview of interventions and avoiding intervening on different components every year. These also help plan interventions using a predefined failure risk threshold in case there are no component-level intervention strategies defined. This threshold is defined as the value of failure risks when all components are in CS4 since having any assets in CS5 is not desirable for the asset managers [13].

An overview of the evolution of failure risks for a selection of track sections is shown in Figure 7. In this figure, TS3 notably exhibits one of the highest failure risks, while TS11 exhibits one of the lowest. The primary reason for this difference is the initial CS of the components on these two track sections, which are in CS4 and CS1, respectively.

4.5. Overview of Component-Level Intervention Requirements

The interventions are estimated for the next planning periods, i.e., t=6 to t=10, and t=11 to t=15 considering deterioration rates and intervention strategies discussed in Section 4. Interventions are scheduled to be executed on a component when the failure risks associated with each track section reach the pre-defined failure risk threshold in each planning period. After knowing which interventions are needed, detailed information regarding the most likely interventions such as the expected costs and possession windows are estimated. These estimates are not done for the period between t = 0 and t = 5 since any interventions between t=0 and t=5 have already entered a detailed planning phase based on the intervention planning process.
Table 7, for example, shows the chances of intervention requirements between t=6 and t=10, along with the estimates of possession windows requirements and the expected costs for only two switches. Based on this table, there is a 34% likelihood that S1 require an intervention. It is most likely that the type of this intervention will be rehabilitation, with 27% likelihood. If this is executed alone, the rehabilitation would be expected to take six hours, of which one would require no disruption to service, one hour would require restrictions to be implemented and four hours would require the associated track section to be closed. This would be expected to cost 263’000 mu.

4.6. Prioritization of Interventions as a Function of the Failure Risk Estimates

Track managers must decide which interventions to postpone in a situation where detailed investigations on all track sections requiring interventions cannot be initiated, or if all interventions can not be executed due to organizational restrictions. The ratio of failure risks associated with the track sections when their components are in their current or predicted CSs, and failure risks associated with the track sections when their components are in CS4 can be used to make such a decision. This failure risk ratio reflects an indication of the failure risk level for each track section, which exists even without any damage. Track managers need to keep this level within a reasonable margin for each track section. At the same time, track managers do not aim to achieve the same failure risk level across all track sections. An example is shown in Figure 8. This would mean that if a detailed investigation of one of the track sections needed to be postponed, it would be the one for TS35, as the failure risks associated with this track section are the farthest away in terms of percentage from the failure risks associated with the track section if all of its components were in CS4.

5. Enabling the Use

Enabling the use of the proposed methodology in the intervention planning process requires some effort from infrastructure managers to initialise the methodology. A schematic overview of the setup and implementation process is also shown in Figure 9. This methodology is designed to be implemented with minimum requirements, e.g., using a computer equipped with spreadsheet software. However, it is recommended to use a programming language such as R [61] to analyse the entire railway network of a country. The estimation of the required information can be achieved using various sources with different levels of detail, from expert opinion to detailed track management databases. After the proper implementation of the proposed methodology, the output can be used to develop intervention programmes that consider all asset-level and network-level constraints such as the interdependencies between the interventions. Moreover, the use of BIM 7 or GIS8 allows for automatic storage and visualisation of the methodology’s output as new information becomes available, which is crucial in a digitalised intervention planning process. For example, the output can be visualised for a selection of track sections that will require interventions on the case study railway network using a GIS platform to provide an overview of the most likely intervention requirement, along with the early estimates of related costs and possession windows over the future planning periods, as shown in Figure 10 for the periods between t = 11 and t = 15 .

6. Discussion

The proposed methodology provides railway asset managers with an efficient overview of the component-level interventions, related costs, possession windows, and associated failure risks over future planning periods. The methodology considers components’ condition, deterioration rates, the interaction between them, component-level intervention strategies, and a tolerable failure risk threshold. Additionally, the methodology enables prioritisation of component-level interventions based on the level of failure risks associated with each track section to decide which one should be selected to initiate the preliminary study phase.
One limitation of the methodology is that even though it is designed to be implemented with minimum effort, the initial estimates of all input information are still required to be made by infrastructure managers, e.g., initial components’ condition, deterioration rates and the impact of their interaction on deterioration rates, possible interventions and their impacts on service and the associated costs as described in the manuscript. This limitation would be the same with all such methodologies. In some parts such as estimating the components’ condition, generating the input information can be made easier using stochastic and data-driven methods.
Additionally, the development of fault trees is deemed demanding, but adequate consideration of failure risk is necessary to support decision-making. From a planer’s perspective, it is useful to have a comprehensive overview of failure risk, i.e., the likelihood and consequences of having to close parts of the railway network for emergency maintenance interventions. From an engineer’s perspective, it is difficult to estimate the probabilities of occurrence of base events and the consequences exactly, which is made harder when there are critiscms of the exactness. This in many cases is likely to mean that the estimates are not made, which unfortunately means risk is not explicitly considered. From a planer perspective, it is preferable to have general, albeit approximate, estimates rather than none at all.
A further challenge is to accurately estimate the potential effects on service, required possession windows, and if required the cost estimates. This challenge arises primarily for two reasons. Firstly, the methodology is to be used at an early planning stage, where there is limited knowledge regarding the specific activities encompassed in the interventions. Even if approximate though, this estimation is essential for acquiring an early yet comprehensive understanding of all track interventions in a railway network. Secondly, even if estimates at the component level were known for individual interventions, the impacts on service and the intervention costs would fluctuate as individual component-level interventions become clustered into cohesive intervention programs. This is because clusterisation results in some interventions being executed earlier or later than they would be executed if the assets were considered alone, and that the combination of some interventions in time with others will likely result in a net reduction of both costs and service disruptions.

7. Conclusions

This manuscript proposes a methodology to estimate interventions, possession times, costs, and failure risks for track sections. It is exemplified through application on a 25km railway network in Switzerland. The novelty of the method includes the focus on components and their interaction overtime, and the use of fault trees to estimate condition-dependent failure risks. The methodology accounts for the factors that are of concern to track managers. It uses a five-state probabilistic model to estimate the current and future CSs and intervention requirements. It uses fault trees to estimate the failure probabilities and consequences for two top events related to different service loss scenarios. The consequences include owner and user costs. To comprehensively assess the advantages of this methodology, future studies should conduct testing on both real-world and simulated networks using different methods such as business processes simulation or structural equations modelling.
The proposed methodology provides a consistent and complete early estimation of component-level interventions, their costs, and associated possession windows as well as failure risks in the upcoming planning periods. The methodology considers the condition of the components, their non-homogeneous deterioration rates as a function of the maintenance count, the interaction between the deteriorating components, and the component-level intervention strategies. Interventions are triggered through the coupling of failure risks with the CS evolution. If deemed necessary, the decisions on postponing interventions or their prioritization can be made using the ratio between predicted failure risks and the failure risk threshold.
The methodology presented herein represents an advancement over the current state-of-the-art practices. It comprehensively encompasses crucial aspects essential in the track managers’ decision-making process. This methodology effectively estimates the failure risks associated with the condition of asset components. Notably, the dynamic adaptation of fault tree calculations for the estimation of condition-dependent failure risks, coupled with a comprehensive overview of intervention requirements, distinguishes this methodology. To the authors’ knowledge, such an application is unprecedented in existing railway asset management systems[44,62].
The systematic overview provided by this methodology in terms of the interventions required, the associated possession windows and the cost estimates streamlines the communication among various stakeholders in the intervention planning process, such as asset managers, line planners, and network developers. Having such a comprehensive overview is crucial for the development of stable train schedules, ensuring that multiple interventions are synergistically integrated within limited time frames.
The design of the proposed methodology was aimed at ensuring the ease of implementation. It allows for the estimation of required input information from several sources, ranging from expert judgment to existing databases, with varying levels of granularity. The accuracy of this input data can be refined further upon the availability of more detailed information. Additionally, other parts of the methodology, such as the definition of CSs can be improved to include indications generated from advanced measuring tools. Moreover, more detailed fault trees can be developed upon the needs of the infrastructure managers. The methodology accounts for the further refinement of component-level intervention strategies. For example, the estimates of the initial CSs can be improved using DBN9 to impute the missing values in the database [41].
Implementing the methodology presented in this manuscript within a suitable platform will enable track managers to efficiently leverage digitalisation. This will facilitate the generation of a detailed overview of the intervention requirements, their initial costs and impacts on the service, as well as the level of failure risks in future planning periods for all track sections in a systematic manner. The adoption and application of the proposed methodology are expected to significantly improve the efficiency and effectiveness of the intervention planning process. For example, the outcomes could be displayed on a GIS-based BIM platform for the entire railway network, including a detailed BIM for each track section to have an improved interpretation of the intervention requirements, their preliminary costs and required possession windows for upcoming planning periods. Future studies should explore these areas, with a particular emphasis on applying the proposed methodology to generate the component-level intervention programmes for all assets within a railway network.

Author Contributions

Conceptualization, H.M., B.T.A, S.M. and C.F.; methodology, H.M., B.T.A, S.M. and C.F.; writing—original draft preparation, H.M., B.T.A.; writing—review and editing, H.M., B.T.A, S.M. and C.F.; visualization, H.M.; supervision, B.T.A, S.M. and C.F.; All authors have read and agreed to the published version of the manuscript.

Data Availability Statement

The data that support the findings of this study contain confidential information and are not publicly available. However, these data may be made available upon reasonable request and subject to appropriate confidentiality agreements.

Acknowledgments

This work is part of STABILITY research project that is supported by the ETH Mobility Initiative and the ETH Zurich Foundation. A large language model has been used to improve the grammar of the text in proofreading. The data used are not publicly available due to confidentiality. However, they can be shared upon reasonable request.

Conflicts of Interest

The authors declare no conflicts of interest.

Appendix A. Bayesian Filters

The Bayesian filters associated with the interaction between fastenings and other track components, sleepers and other track components, and ballasts and other components are respectively shown in Equation A1, A2, and A3. The same values as the ones discussed in Section 4.2 are used for these filters.Please note that the deterioration rate of subgrades is assumed to be independent of the CSs of other track components.
Γ F a s t e n i n g s = I if C S S l e e p e r s = { 1 , 2 } | C S B a l l a s t s = { 1 , 2 } | C S S u b g r a d e s = { 1 , 2 } I i i α i { 1 , 2 , 3 , 4 } if C S S l e e p e r s = { 3 } | C S B a l l a s t s = { 3 } I i ( i + 1 ) + α i { 1 , 2 , 3 , 4 } | C S S u b g r a d e s = { 3 } I i i β i { 1 , 2 , 3 , 4 } if C S S l e e p e r s = { 4 } | C S B a l l a s t s = { 4 } I i ( i + 1 ) + β i { 1 , 2 , 3 , 4 } | C S S u b g r a d e s = { 4 } I i i η i { 1 , 2 , 3 , 4 } if C S S l e e p e r s = { 5 } | C S B a l l a s t s = { 5 } I i ( i + 1 ) + η i { 1 , 2 , 3 , 4 } | C S S u b g r a d e s = { 5 }
Γ S l e e p e r s = I if C S B a l l a s t s = { 1 , 2 } | C S S u b g r a d e s = { 1 , 2 } I i i α i { 1 , 2 , 3 , 4 } if C S B a l l a s t s = { 3 } | C S S u b g r a d e s = { 3 } I i ( i + 1 ) + α i { 1 , 2 , 3 , 4 } I i i β i { 1 , 2 , 3 , 4 } if C S B a l l a s t s = { 4 } | C S S u b g r a d e s = { 4 } I i ( i + 1 ) + β i { 1 , 2 , 3 , 4 } I i i η i { 1 , 2 , 3 , 4 } if C S B a l l a s t s = { 5 } | C S S u b g r a d e s = { 5 } I i ( i + 1 ) + η i { 1 , 2 , 3 , 4 }
Γ B a l l a s t s = I if C S S u b g r a d e s = { 1 , 2 } I i i α i { 1 , 2 , 3 , 4 } if C S S u b g r a d e s = { 3 } I i ( i + 1 ) + α i { 1 , 2 , 3 , 4 } I i i β i { 1 , 2 , 3 , 4 } if C S S u b g r a d e s = { 4 } I i ( i + 1 ) + β i { 1 , 2 , 3 , 4 } I i i η i { 1 , 3 } if C S S u b g r a d e s = { 5 } = γ i ( i + 1 ) + η i { 1 , 2 , 3 , 4 }

References

  1. Adey, B.T. A road infrastructure asset management process: gains in efficiency and effectiveness. Infrastructure Asset Management 2018, 6, 2–14. [Google Scholar] [CrossRef]
  2. Burkhalter, M.; Adey, B.T. Required accuracy of information when determining optimal railway intervention programmes. Infrastructure Asset Management 2021, pp. 1–10. [CrossRef]
  3. Giunta, M.; Bressi, S.; D’Angelo, G. Life cycle cost assessment of bitumen stabilised ballast: A novel maintenance strategy for railway track-bed. Construction and Building Materials 2018, 172, 751–759. [Google Scholar] [CrossRef]
  4. O’Connor, K.; Wynd, B.; Cunningham, G.; MacPherson, D. Maintenance of early reinforced-concrete road bridges in Aberdeenshire, Scotland. Proceedings of the Institution of Civil Engineers: Bridge Engineering 2019, 172, 293–302. [Google Scholar] [CrossRef]
  5. Fecarotti, C.; Andrews, J. Optimising strategy selection for the management of railway assets. 2017.
  6. Fecarotti, C.; Andrews, J.D.; Pesenti, R. A mathematical programming model to select maintenance strategies in railway networks. Reliability Engineering & System Safety 2021, 216, 107940. [Google Scholar] [CrossRef]
  7. Calvert, G.; Neves, L.; Andrews, J.; Hamer, M. Modelling the interactions between defect mechanisms on metal bridges. Bridge Maintenance, Safety, Management, Life-Cycle Sustainability and Innovations - Proceedings of the 10th International Conference on Bridge Maintenance, Safety and Management, IABMAS 2020 2021, pp. 2743–2751. Publisher: CRC Press/Balkema ISBN: 9780429279119. [CrossRef]
  8. Mirzaei, Z.; Adey, B.T.; Klatter, L.; Thompson, P.D.; Klatter, L. Overview of existing Bridge Management Systems. In Proceedings of the (also presented the 7th International Conference on Bridge Maintenance, Safety and Management, IABMAS, Italy), Zurich, Switzerland, 2014. Issue: June 2014., Italy).
  9. Ricketts, N. Railway Bridge Maintenance, second edition ed.; ICE Publishing: London, 2017. [Google Scholar] [CrossRef]
  10. Lethanh, N.; Adey, B.T.; Fernando, D.N. Optimal intervention strategies for multiple objects affected by manifest and latent deterioration processes. Structure and Infrastructure Engineering 2015, 11, 389–401. [Google Scholar] [CrossRef]
  11. Kobayashi, K.; Kaito, K.; Lethanh, N. A competing Markov model for cracking prediction on civil structures. Transportation Research Part B: Methodological 2014, 68, 345–362. [Google Scholar] [CrossRef]
  12. Fecarotti, C.; Andrews, J.D. Producing effective maintenance strategies to control railway risk. Probabilistic Safety Assessment and Management PSAM 2018, 14. [Google Scholar]
  13. Mehranfar, H.; Adey, B.T.; Moghtadernejad, S.; Chuo, S. Automated early estimation of bridge interventions, possession windows and costs. Infrastructure Asset Management 2023, pp. 1–13. Publisher: ICE Publishing. [CrossRef]
  14. Kaewunruen, S.; Osman, M.H.; Hao Cheng Eric, W. Risk-Based Maintenance Planning for Rail Fastening Systems. ASCE-ASME Journal of Risk and Uncertainty in Engineering Systems, Part A: Civil Engineering 2019, 5, 04019007. [Google Scholar] [CrossRef]
  15. Mahmoud, H.; Zafar, A. Time-Dependent Reliability Analysis of Reinforced-Concrete Bridges Including Deterioration Effects. In Proceedings of the Geotechnical and Structural Engineering Congress 2016 - Proceedings of the Joint Geotechnical and Structural Engineering Congress 2016, Phoenix, Arizona, 2016. [CrossRef]
  16. Adey, B.T.; Hajdin, R. Methodology for determination of financial needs of gradually deteriorating bridges with only structure level data. Structure and Infrastructure Engineering 2011, 7, 645–660. [Google Scholar] [CrossRef]
  17. Allah Bukhsh, Z.; Stipanovic, I.; Doree, A.G. Multi-year maintenance planning framework using multi-attribute utility theory and genetic algorithms. European Transport Research Review 2020, 12, 3. [Google Scholar] [CrossRef]
  18. Bressi, S.; Santos, J.; Losa, M. Optimization of maintenance strategies for railway track-bed considering probabilistic degradation models and different reliability levels. Reliability Engineering & System Safety 2021, 207, 107359. [Google Scholar] [CrossRef]
  19. Chiachío, J.; Chiachío, M.; Prescott, D.; Andrews, J.D. A knowledge-based prognostics framework for railway track geometry degradation. Reliability Engineering & System Safety 2019, 181, 127–141. [Google Scholar] [CrossRef]
  20. Consilvio, A.; Vignola, G.; López Arévalo, P.; Gallo, F.; Borinato, M.; Crovetto, C. A data-driven prioritisation framework to mitigate maintenance impact on passengers during metro line operation. European Transport Research Review 2024, 16, 6. [Google Scholar] [CrossRef]
  21. Fecarotti, C.; Andrews, J. A Petri net approach to assess the effects of railway maintenance on track availability. Infrastructure Asset Management 2020, 7, 201–220. [Google Scholar] [CrossRef]
  22. Hidirov, S.; Guler, H. Reliability, availability and maintainability analyses for railway infrastructure management. Structure and Infrastructure Engineering 2019, 15, 1221–1233. [Google Scholar] [CrossRef]
  23. Irfan, M.; Khurshid, M.B.; Iqbal, S.; Khan, A. Framework for airfield pavements management—an approach based on cost-effectiveness analysis. European Transport Research Review 2015, 7, 1–14. [Google Scholar] [CrossRef]
  24. Le, B.; Andrews, J.D.; Fecarotti, C. A Petri net model for railway bridge maintenance:. http://dx.doi.org/10.1177/1748006X17701667 2017, 231, 306–323. Publisher: SAGE PublicationsSage UK: London, England. [CrossRef]
  25. Papathanasiou, N.; Adey, B.T. Making Comparable Risk Estimates for Railway Assets of Different Types. Infrastructure Asset Management 2020, (accepted).
  26. Prescott, D.; Andrews, J. Investigating railway track asset management using a Markov analysis. Proceedings of the Institution of Mechanical Engineers, Part F: Journal of Rail and Rapid Transit 2015, 229, 402–416. [Google Scholar] [CrossRef]
  27. Prescott, D.; Andrews, J. A track ballast maintenance and inspection model for a rail network. Proceedings of the Institution of Mechanical Engineers, Part O: Journal of Risk and Reliability 2013, 227, 251–266. [Google Scholar] [CrossRef]
  28. Rúa, E.; Comesaña-Cebral, L.; Arias, P.; Martínez-Sánchez, J. A top-down approach for a multi-scale identification of risk areas in infrastructures: particularization in a case study on road safety. European Transport Research Review 2022, 14, 39. [Google Scholar] [CrossRef]
  29. Sadeghi, J.; Motieyan-Najar, M.E.; Zakeri, J.A.; Yousefi, B.; Mollazadeh, M. Improvement of railway ballast maintenance approach, incorporating ballast geometry and fouling conditions. Journal of Applied Geophysics 2018, 151, 263–273. [Google Scholar] [CrossRef]
  30. Sancho, L.C.B.; Braga, J.A.P.; Andrade, A.R. Optimizing Maintenance Decision in Rails: A Markov Decision Process Approach. ASCE-ASME Journal of Risk and Uncertainty in Engineering Systems, Part A: Civil Engineering 2021, 7, 04020051. [Google Scholar] [CrossRef]
  31. Sasidharan, M.; Burrow, M.P.; Ghataora, G.S. A whole life cycle approach under uncertainty for economically justifiable ballasted railway track maintenance. Research in Transportation Economics 2020, 80, 100815. [Google Scholar] [CrossRef]
  32. Sharma, S.; Cui, Y.; He, Q.; Mohammadi, R.; Li, Z. Data-driven optimization of railway maintenance for track geometry. Transportation Research Part C: Emerging Technologies 2018, 90, 34–58. [Google Scholar] [CrossRef]
  33. Soleimanmeigouni, I.; Ahmadi, A.; Nissen, A.; Xiao, X. Prediction of railway track geometry defects: a case study. Structure and Infrastructure Engineering 2020, 16, 987–1001. [Google Scholar] [CrossRef]
  34. Sresakoolchai, J.; Kaewunruen, S. Railway infrastructure maintenance efficiency improvement using deep reinforcement learning integrated with digital twin based on track geometry and component defects. Scientific Reports 2023 13:1 2023, 13, 1–16. [Google Scholar] [CrossRef]
  35. Usman, K.; Burrow, M.; Ghataora, G. Railway track subgrade failure mechanisms using a fault chart approach. Procedia Engineering 2015, 125, 547–555. [Google Scholar] [CrossRef]
  36. Usman, K.; Burrow, M.P.N.; Ghataora, G.S.; Sasidharan, M. Using Probabilistic Fault Tree Analysis and Monte Carlo Simulation to Examine the Likelihood of Risks Associated with Ballasted Railway Drainage Failure:. https://doi.org/10.1177/0361198120982310 2021, 2675, 70–89. Publisher: SAGE PublicationsSage CA: Los Angeles, CA. [CrossRef]
  37. Vale, C.; Simões, M.L. Prediction of Railway Track Condition for Preventive Maintenance by Using a Data-Driven Approach. Infrastructures 2022, 7, 34. [Google Scholar] [CrossRef]
  38. Vandoorne, R.; Gräbe, P.J. Stochastic modelling for the maintenance of life cycle cost of rails using Monte Carlo simulation. Proceedings of the Institution of Mechanical Engineers, Part F: Journal of Rail and Rapid Transit 2018, 232, 1240–1251. [Google Scholar] [CrossRef]
  39. Wenfei, B.; Yun, W.; Rengkui, L. Optimization Model of Life Cycle Repair Decisions for Track Network. Journal of Transportation Engineering, Part A: Systems 2022, 148. [Google Scholar] [CrossRef]
  40. Jalili Hassankiadeh, S. Failure analysis of railway switches and crossings for the purpose of preventive maintenance. 2011.
  41. Chuo, S.; Moghtadernejad, S.; Adey, B.T.; Mehranfar, H. Estimation of bridge component condition states with varying data availability. In Proceedings of the Life-Cycle of Structures and Infrastructure Systems, Milan, Italy; 2023. [Google Scholar]
  42. Moghtadernejad, S.; Huber, G.; Hackl, J.; Adey, B.T. Data-driven estimation of deterioration curves: a railway supporting structures case study. https://doi.org/10.1680/jinam.21.00006 2021, pp. 1–15. Publisher: Thomas Telford Ltd. [CrossRef]
  43. Mizutani, D.; Lethanh, N.; Adey, B.T.; Kaito, K. Improving the estimation of markov transition probabilities using mechanistic-empirical models. Frontiers in Built Environment 2017, 3, 58. [Google Scholar] [CrossRef]
  44. Tzanakakis, K. Tzanakakis, K. The Railway Track and Its Long Term Behaviour 2013. 2. Publisher: Springer Berlin Heidelberg Place: Berlin, Heidelberg ISBN: 978-3-642-36050-3. [CrossRef]
  45. Kosič, M.; Anžlin, A.; Bau’, V. Flood vulnerability assessment: an effective tool to evaluate the lifecycle risk analysis of bridges. ce/papers 2023, 6, 817–823. [Google Scholar] [CrossRef]
  46. Sathya, S.U.; Mahmoodian, M.; Bandara, C.S.; Naderpajouh, N.; Dissanayake, P.B.R. Fragility Prediction for Earthquake-Induced Embankment Failures Through Empirical Methods. In Proceedings of the ICSBE 2022; Dissanayake, R.; Mendis, P.; Weerasekera, K.; De Silva, S.; Fernando, S.; Konthesingha, C.; Gajanayake, P., Eds., Singapore, 2023; Lecture Notes in Civil Engineering; pp. 519–535. [Google Scholar] [CrossRef]
  47. Federal Statistical Office. Baupreisindex - Durchschnittliche Einheitspreise in der Schweiz und in den Grossregione. Technical report, 2021.
  48. Asmussen, B. Overview of Methods for Measurement of Track Irregularities Important for Ground-Borne Vibration Deliverable D2.5 2013.
  49. Kim, H. Trackside measurement of critical zones in railway tracks. PhD thesis, 2016.
  50. SBB Infrastruktur. Network Status Report 2020. Technical report, VöV, Bern, Switzerland, 2020. Issue: März.
  51. Engineering Track Maintenance Field Handbook. Technical report, Union Pacific, 2022.
  52. Mosayebi Omshi, E.; Grall, A. Replacement and imperfect repair of deteriorating system: Study of a CBM policy and impact of repair efficiency. Reliability Engineering and System Safety 2021, 215, 107905. [Google Scholar] [CrossRef]
  53. Chen, J.; Ren, L.; Li, J. Research on imperfect condition-based maintenance strategy based on accelerated degradation process. Measurement and Control 0, 0, 00202940231207709, [https://doi.org/10.1177/00202940231207709]. [CrossRef]
  54. Peng, J.; Liu, B.; Liu, Y.; Xu, X. Condition-Based Maintenance Policy for Systems With a Non-Homogeneous Degradation Process. IEEE Access 2020, 8, 81800–81811. [Google Scholar] [CrossRef]
  55. Li, M.; Jia, G. Age, state, and environment dependent non-homogeneous stochastic model for improved bridge deterioration prediction. In Proceedings of the Bridge Maintenance, Safety, Management, Life-Cycle Sustainability and Innovations. CRC Press, 2021. Num Pages: 8. [Google Scholar]
  56. Wellalage, N.K.W.; Zhang, T.; Dwight, R. Calibrating Markov Chain–Based Deterioration Models for Predicting Future Conditions of Railway Bridge Elements. Journal of Bridge Engineering 2015, 20, 04014060. [Google Scholar] [CrossRef]
  57. Shen, Y.; Goodall, J.L.; Chase, S.B. Condition State–Based Civil Infrastructure Deterioration Model on a Structure System Level. Journal of Infrastructure Systems 2019, 25, 04018042. [Google Scholar] [CrossRef]
  58. Mehranfar, H.; Moghtadernejad, S.; Adey, B.T.; Fecarotti, C. Improving the planning of future track interventions using digital tools. In Proceedings of the TRA Dublin 2024 Conference Proceedings Transport Research Arena (TRA Dublin 2024), Dublin; 2024. [Google Scholar]
  59. Ozbek, M.E.; de la Garza, J.M.; Triantis, K. Efficiency Measurement of Bridge Maintenance Using Data Envelopment Analysis. Journal of Infrastructure Systems 2010, 16, 31–39. [Google Scholar] [CrossRef]
  60. Zhang, Z.; Agbelie, B.R.; Labi, S. Efficiency Measurement of Bridge Management with Data Envelopment Analysis. Transportation Research Record 2015, 2481, 1–9. [Google Scholar] [CrossRef]
  61. R Core Team. R: A Language and Environment for Statistical Computing; R Foundation for Statistical Computing: Vienna, Austria, 2024. [Google Scholar]
  62. Kim, S.; Ge, B.; Frangopol, D.M. Probabilistic Optimum Bridge System Maintenance Management Considering Correlations of Deteriorating Components and Service Life Extensions. ASCE-ASME Journal of Risk and Uncertainty in Engineering Systems, Part A: Civil Engineering 2022, 8. [Google Scholar] [CrossRef]
1
FR: Failure Risks,IS: Intervention Strategies
1
I is anidentity matrix.
0
Note: The bests witch intervention strategy is highlighted inviolet.
1
Potential activities: Tightening of the fastenings, Tamping or ballast cleaning, lubrication of the switch blades, adjustment of switch settings.
2
Potential activities: Restoration of the rail surface by welding, manual grinding.
3
Potential activities: Replacing the damaged parts of the switch.
0
Note:The values associated with the most likely interventions are indicated in bold.
1
The chance of the intervention being rehabilitation /renewal /replacement (%)
2
Building Information Modelling
3
Geographic Information System
4
Dynamic Bayesian Network
Figure 1. The steps of the proposed methodology to enable digitalised intervention planning process.
Figure 1. The steps of the proposed methodology to enable digitalised intervention planning process.
Preprints 147344 g001
Figure 2. The schematic overview of the case study.
Figure 2. The schematic overview of the case study.
Preprints 147344 g002
Figure 3. The latest condition distribution of the example tracks and switches.
Figure 3. The latest condition distribution of the example tracks and switches.
Preprints 147344 g003
Figure 4. A schematic overview of track components.
Figure 4. A schematic overview of track components.
Preprints 147344 g004
Figure 5. Overview of the CS of the track components at: (a) t = 0 , and (b) t = 5 . A caption on a single line should be centered.
Figure 5. Overview of the CS of the track components at: (a) t = 0 , and (b) t = 5 . A caption on a single line should be centered.
Preprints 147344 g005
Figure 6. Examples of failure trees associated with: (a) restriction service, and (b) interrupted service. A caption on a single line should be centered.
Figure 6. Examples of failure trees associated with: (a) restriction service, and (b) interrupted service. A caption on a single line should be centered.
Preprints 147344 g006
Figure 7. Overview of the failure risk evolution for a selection of track sections between t = 6 and t = 15 .
Figure 7. Overview of the failure risk evolution for a selection of track sections between t = 6 and t = 15 .
Preprints 147344 g007
Figure 8. Failure risks with predicted CSs of components/failure risks with components in CS4 × 100 % between t = 6 and t = 10 .
Figure 8. Failure risks with predicted CSs of components/failure risks with components in CS4 × 100 % between t = 6 and t = 10 .
Preprints 147344 g008
Figure 9. Schematic overview of the setup and implementation workflow within a digitalized infrastructure management process.
Figure 9. Schematic overview of the setup and implementation workflow within a digitalized infrastructure management process.
Preprints 147344 g009
Figure 10. Most likely intervention requirements on the GIS model of the case study between t = 11 and t = 15 .
Figure 10. Most likely intervention requirements on the GIS model of the case study between t = 11 and t = 15 .
Preprints 147344 g010
Table 3. Definition of the CSs for switches.
Table 3. Definition of the CSs for switches.
CS Condition Description Damage Description Damage Indicator
1 New None/insignificant No significant damages, no sign of settlement.
2 Good Minor Slight wear on the mechanism, a slight sign of debris accumulation, a slight sign of settlement.
3 Sufficient Significant Insignificant signs of wear on the switchblade, Insignificant sign of wear on the crossing nose, small areas with slight corrosion, insignificant accumulation of debris, the amount of settlement reaches the alarm threshold.
4 Poor Extensive The frog shows some damage, switchblades damaged, switch actuator/motor can fail, significant accumulation of debris, the amount of settlement reaches the intervention threshold.
5 Insufficient Safety is endangered Plastic deformation of the crossing nose, loss of stability due to severe corrosion of the frog, extreme accumulation of debris actuator/motor have a high failure probability, the amount of settlement reaches the maximum tolerable threshold.
Table 4. Example transition probabilities for switches.
Table 4. Example transition probabilities for switches.
1st Maintenance 2nd Maintenance
CS 1 2 3 4 5 1 2 3 4 5
1 0.84 0.16 - - - 0.82 0.18 - -
2 - 0.72 0.28 - 0.70 0.30 - - -
3 - - 0.56 0.44 - - 0.54 0.46 -
4 - - - 0.32 0.68 - - 0.30 0.70
5 - - - - - - - - -
Table 5. Example switch intervention costs.
Table 5. Example switch intervention costs.
Intervention Type C O ( mu / quantity ) Service Disturbance Duration ( h ) C U ( mu ) C Total ( mu )
Rehabilitation 3’110 4 260’496 263’606
Renewal 3’930 4 260’496 264’426
Replacement 14’110 8 520’992 535’102
Table 6. Example intervention effectiveness for switches.
Table 6. Example intervention effectiveness for switches.
Intervention Type CS1 CS2 CS3 CS4 CS5
CS3 Rehabilitation[1] 0.85 0.15 - - -
Renewal 0.95 0.05 - - -
Replacement 1.00 - - - -
CS4 Rehabilitation 0.65 0.35 - - -
Renewal[2] 0.90 0.10 - - -
Replacement 1.00 - - - -
CS5 Rehabilitation 0.50 0.50 - - -
Renewal 0.85 0.15 - - -
Replacement[3] 1.00 - - - -
Table 7. Possible and most likely switch interventions required between t = 6 and t = 10, with associated possessions and intervention costs
Table 7. Possible and most likely switch interventions required between t = 6 and t = 10, with associated possessions and intervention costs
Expected Required
Possessions (h) If Done Alone
Switch Name Chance of an Intervention(%) Details[1] Expected Duration (h) None Traffic Restrictions Closure Expected Intervention Costs ( × 10 3 mu)
S1 34 27/6/1 6/7/11 1/1/1 1/2/2 4/4/8 263/264/535
S2 100 -/47/53 6/7/11 1/1/1 1/2/2 4/4/8 263/264/535
Disclaimer/Publisher’s Note: The statements, opinions and data contained in all publications are solely those of the individual author(s) and contributor(s) and not of MDPI and/or the editor(s). MDPI and/or the editor(s) disclaim responsibility for any injury to people or property resulting from any ideas, methods, instructions or products referred to in the content.
Copyright: This open access article is published under a Creative Commons CC BY 4.0 license, which permit the free download, distribution, and reuse, provided that the author and preprint are cited in any reuse.
Prerpints.org logo

Preprints.org is a free preprint server supported by MDPI in Basel, Switzerland.

Subscribe

Disclaimer

Terms of Use

Privacy Policy

Privacy Settings

© 2025 MDPI (Basel, Switzerland) unless otherwise stated
